PLC-Controlled Sand Conditioning

Clay Sand Preparation Line The Quality Control Stage Before Molding

A clay sand preparation line is the mixing and conditioning system that takes raw sand, clay additives, and water and outputs production-ready molding sand with controlled moisture, clay content, and temperature. It's the first stage in the clay sand processing loop — the equipment that feeds your molding line with consistent batches, shift after shift.

TZFoundry clay sand preparation line — PLC-controlled mixing and conditioning system for foundry molding sand

What This System Covers — and Where It Fits

This isn't the complete clay sand processing line (which includes molding, reclamation, and washing in a closed loop). It's the front-end subsystem that handles sand preparation before molding. If you already have molding equipment but need to upgrade your mixing system, or if you're building a line in stages and want to start with the quality control checkpoint, this is the equipment you're specifying.

We build clay sand preparation lines as standalone systems that integrate with existing foundry equipment — different molding line brands, non-standard conveyor heights, specific clay types your operation requires.

Why the Preparation Stage Controls Your Defect Rates

The preparation line determines batch consistency for everything downstream. Inconsistent sand parameters cascade into mold failures and casting defects at the pour stage.

Moisture Variation ±3-4%

Common with manual mixing. Your molding line produces molds with inconsistent strength — some crack during handling, others don't release cleanly from patterns. Direct impact on scrap rates and pattern wear.

Clay Content Drift ±2-3%

Mold permeability changes between batches. Result: gas defects in castings — porosity, blowholes, and surface pitting that require rework or scrap the part entirely.

PLC-Controlled Preparation: The Numbers

Our systems use PLC control with inline sensors to maintain moisture at ±1.5% of target and clay content at ±1.5% across continuous operation. Manual mixing systems typically run ±3-5% on both parameters.

That difference shows up in your defect rates: foundries that upgraded from manual to PLC-controlled preparation report 15-20% reductions in mold-related casting defects (cracks, gas porosity, dimensional variation).

Cost-Benefit Summary

~40%

Equipment cost premium for PLC control over manual systems

12-18 mo

Typical payback period from defect reduction for mid-volume operations

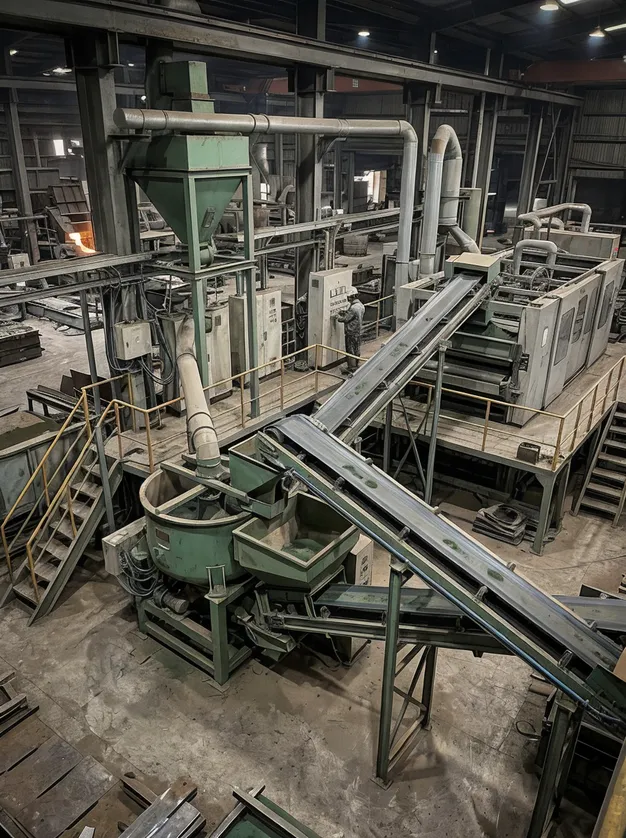

TZFoundry clay sand preparation line integrated with existing foundry molding equipment

Built for Integration With Your Existing Equipment

We've been building clay sand preparation equipment since 2010, starting with standalone mixers for domestic foundries and moving to integrated preparation lines when export buyers needed systems that connected to their existing molding equipment without custom engineering on their end.

A clay sand preparation line manufacturer that works with overseas buyers needs to handle integration variables — different conveyor interface heights, non-standard clay types, voltage and control system compatibility with equipment you already own. Our in-house engineering team adapts standard designs to fit your facility constraints without outsourcing to third-party integrators who add lead time and coordination overhead.

Different molding line brands

Non-standard conveyor heights

Specific clay type requirements

Voltage & control system compatibility

System Integration — What Feeds In, What Feeds Out

Clay sand preparation sits between raw material storage and molding. Upstream, you're feeding in raw sand (from storage silos or reclaimed sand from your reclamation system), clay additives (from bulk bags or pneumatic silos), and water (from facility supply or a closed-loop recycling system). Downstream, the preparation line outputs conditioned sand to your molding line — either directly via conveyor or through intermediate storage hoppers that buffer production rate differences between preparation and molding.

Upstream Inputs
  • Raw sand from storage silos or reclaimed sand from reclamation system
  • Clay additives from bulk bags or pneumatic silos
  • Water from facility supply or closed-loop recycling system

Clay Sand Preparation Line

PLC-Controlled Mixing & Conditioning

Downstream Output
  • Conditioned sand to molding line — directly via conveyor
  • Intermediate storage hoppers that buffer production rate differences between preparation and molding

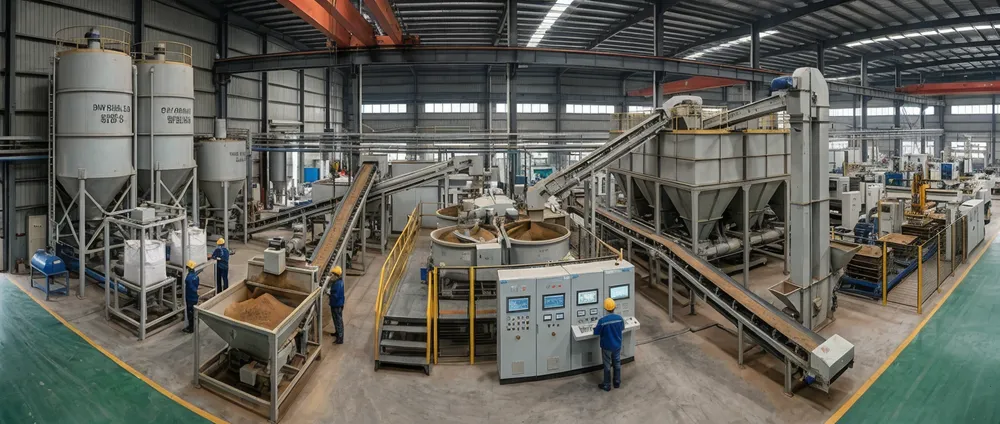

Clay sand preparation line system integration flow — upstream raw material inputs through PLC-controlled mixing to downstream molding line output

Integration Points That Matter

The integration points that matter: conveyor discharge height (needs to match your molding line's feed hopper inlet), control system compatibility (if your molding line uses Siemens PLCs, we can configure the preparation line's controller to share data over Profibus or Ethernet/IP), and production rate matching (preparation capacity should run 110–120% of molding line consumption to maintain buffer inventory during peak shifts).

Conveyor Discharge Height

Needs to match your molding line's feed hopper inlet. Mismatches require additional transfer conveyors or elevation changes that add cost and failure points.

Control System Compatibility

If your molding line uses Siemens PLCs, we configure the preparation line's controller to share data over Profibus or Ethernet/IP for unified production monitoring.

Production Rate Matching

Preparation capacity should run 110–120% of molding line consumption to maintain buffer inventory during peak shifts.

Most integration problems trace back to mismatched capacities — a preparation line rated for 8 tons per hour feeding a molding line that consumes 10 tons per hour during full production creates a backlog that forces you to either slow down molding or bypass the preparation system and use inconsistent manual mixing.

Upstream Connections

Raw sand typically feeds via belt conveyor or bucket elevator from ground-level storage. If you're integrating reclaimed sand, the preparation line needs a dual-input system that blends fresh and reclaimed sand in controlled ratios — common split is 70% reclaimed, 30% fresh for most gray iron and ductile iron work.

Clay additives feed through screw conveyors or pneumatic transport from bulk storage — we size the clay feeder based on your target clay content (6–10% by weight for most applications) and production rate. Water injection happens in the mixer through spray nozzles controlled by the PLC based on real-time moisture sensor feedback.

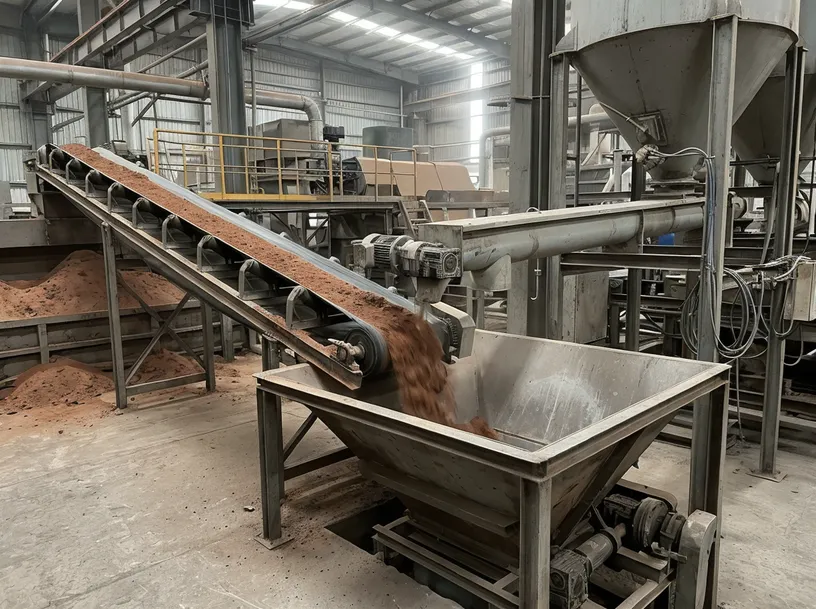

Upstream connections — dual-input sand feed system with belt conveyor and clay additive screw conveyor for clay sand preparation line

70 / 30

Reclaimed / Fresh Sand Ratio

6–10%

Target Clay Content (by weight)

Real-Time

PLC Moisture Sensor Feedback

Downstream Connections

Prepared sand exits the mixer via discharge conveyor. Standard discharge height is 1,200mm above floor level, but TZFoundry adjusts this to match your molding line's feed hopper — systems have been built with discharge heights from 800mm to 2,500mm depending on the buyer's existing equipment layout.

If your molding line runs intermittently or at variable rates, add a storage hopper between preparation and molding. Typical hopper capacity is 2–4 hours of molding line consumption, which gives you buffer time for preparation line maintenance or batch adjustments without stopping molding.

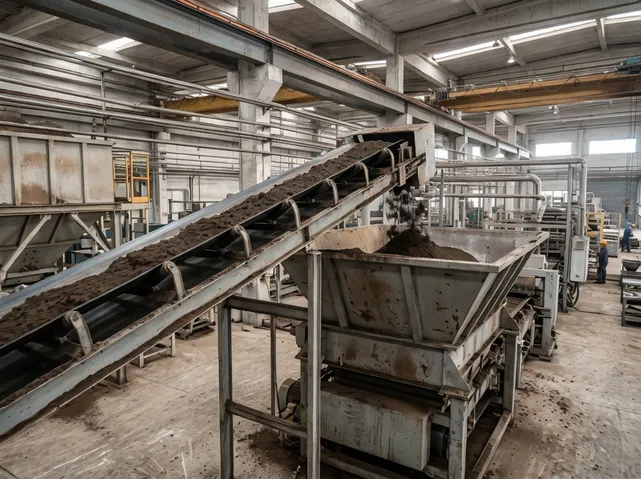

Clay sand preparation line discharge conveyor connecting to molding line feed hopper

Discharge height adjustable from 800mm to 2,500mm to match existing molding line feed hoppers.

Buffer Hopper Sizing Tip

Size the intermediate storage hopper for 2–4 hours of molding line consumption. This decouples the preparation and molding schedules — you can perform batch adjustments, run maintenance, or accommodate intermittent molding without shutting down either system. The hopper acts as a scheduling buffer, not just a sand tank.

Control System Integration

Two operating modes are available, depending on how your facility is structured:

Standalone Operation

Uses the preparation line's dedicated PLC with a local touchscreen interface. Operators set moisture and clay targets, and the system runs autonomously. Best suited for facilities without centralized supervision or where the preparation line operates independently from other equipment.

Integrated Operation

Connects the preparation PLC to your facility's supervisory control system (SCADA) or directly to the molding line's controller. This enables coordinated operation: the molding line signals when it needs more sand, the preparation line ramps up production, and both systems log batch data to a central database for quality traceability.

Supported Communication Protocols

Modbus TCP
Profibus
Ethernet/IP
OPC-UA

These protocols cover integration with most industrial control systems in foundry environments, including Siemens, Allen-Bradley, Mitsubishi, and other major PLC platforms.

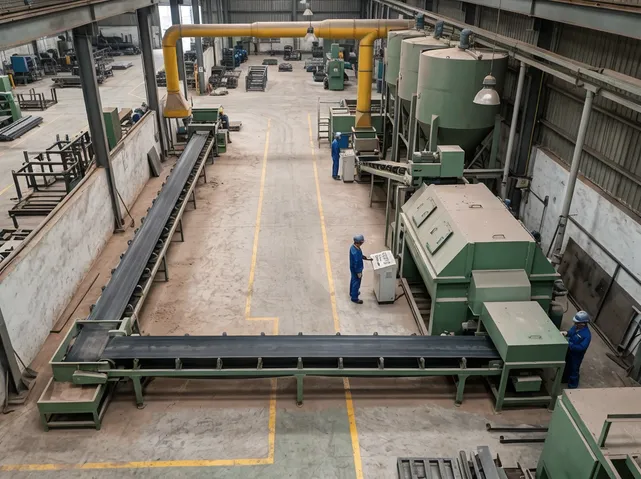

Physical Layout Considerations

Preparation lines need 8–12 meters of floor space (length depends on mixer capacity and conveyor configuration) and 3–4 meters of width. Ceiling height requirement varies by sand-feed method:

Vertical Bucket Elevators

Requires 4–5 meters ceiling height.

Horizontal Belt Conveyors

Reduces height requirement to 3 meters.

The mixer generates vibration during operation, so install on a reinforced concrete foundation at least 200mm thick with rebar reinforcement.

Clay sand preparation line physical layout showing floor space and conveyor configuration options

Typical footprint: 8–12m × 3–4m. L-shaped and U-shaped layouts available for retrofit installations.

Retrofitting Into Existing Facilities

If you're retrofitting into an existing facility, TZFoundry can configure L-shaped or U-shaped conveyor layouts to fit around columns or other equipment. This adds about 10% to the base system cost but avoids the expense of relocating existing infrastructure — often the more economical path for brownfield installations.

Integration with Non-Standard Equipment

Most molding lines use standard 400 mm or 500 mm wide belt conveyors for sand feeding. If your equipment uses different widths, pneumatic transport, or screw conveyors, tell us during the quotation phase — we'll match the interface.

We've integrated preparation lines with molding equipment from 15+ different manufacturers (Chinese, European, and North American brands), and the common integration challenges are:

Conveyor Speed Matching

Solved with variable-frequency drives on the discharge conveyor, allowing real-time speed synchronization with your molding line's draw rate.

Control Signal Compatibility

Solved with protocol converters or relay interfaces if direct PLC communication isn't feasible — ensuring the preparation line responds correctly to start/stop, demand, and fault signals from your existing automation.

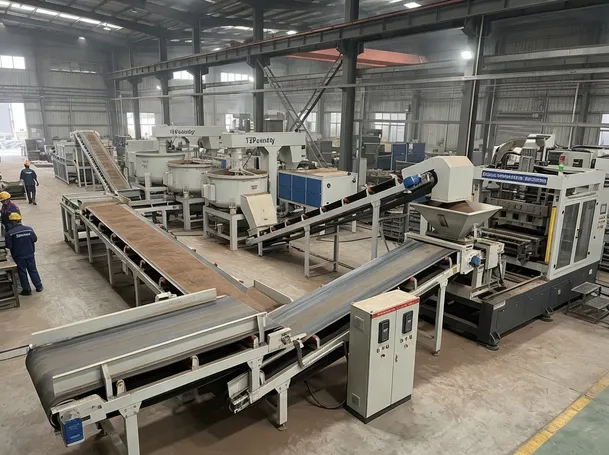

TZFoundry clay sand preparation line integrated with non-standard conveyor widths and third-party molding equipment

Capacity Matching Example

A molding line producing 120 molds per hour, with each mold using 25 kg of sand, consumes 3 tons of sand per hour.

120 molds/hr × 25 kg/mold = 3 t/hr

Size the preparation line for 3.5–4 tons per hour to maintain buffer capacity.

Plan Ahead

Mixer Upgrade Cost

If you're planning to add a second molding line in the future, oversize the preparation system now. Upgrading mixer capacity later requires replacing the entire mixer assembly, which costs 60–70% of a new system.

Downstream Expansion

Adding downstream conveyors and hoppers for a second molding line is straightforward and costs only 15–20% of the base preparation system — a fraction of the mixer replacement path.

Need help sizing or integrating with your existing line?

Share your molding line specs and we'll provide a matched preparation line configuration — including conveyor interfaces and PLC integration scope.

Get Integration Advice
Specifications & Configurations

Technical Specifications & Configuration Options

Clay sand preparation lines scale across three capacity ranges, and the differences between them aren't just throughput — they're about control precision, automation level, and integration complexity. A small-scale system uses manual control and batch mixing. A mid-scale system adds PLC control and continuous mixing. A high-volume system runs full automation with inline quality sensors and predictive maintenance monitoring.

Specification Small-Scale Mid-Scale High-Volume
Capacity 3–5 tons/hour 8–12 tons/hour 15–20+ tons/hour
Mixer Type Paddle mixer, batch Paddle mixer, continuous High-shear mixer, continuous
Control System Manual setpoints PLC with touchscreen PLC + inline sensors + SCADA
Moisture Control ±3–5% (manual adjustment) ±1.5% (PLC feedback) ±1% (inline sensor + auto-adjust)
Clay Content Control ±3–4% (manual dosing) ±1.5% (PLC-controlled feeder) ±1% (inline analyzer + feedback)
Power Requirement 15–22 kW 30–45 kW 60–85 kW
Footprint 8m × 3m 10m × 3.5m 12m × 4m
Operators Required 1 per shift 1 per shift (monitoring) 1 per shift (exception handling)

Small-Scale Configuration (3–5 tons/hour)

This setup works for foundries running 1–2 shifts with batch production or frequent product changeovers. The mixer operates in batch mode — load sand, add clay and water, mix for 3–5 minutes, discharge, repeat. Operators set moisture and clay targets manually based on lab tests or experience, and adjust water flow and clay dosing between batches if the previous batch was off-spec.

Mixing uniformity is sufficient for most gray iron and ductile iron casting work (density variation under 8% across the batch), but you'll see more variation than continuous systems.

When this configuration makes sense

Your molding line runs intermittently, or you're casting a wide product mix that requires different sand formulations — some molds need 8% clay for strength, others need 6% for permeability.

The trade-off

Batch-to-batch consistency depends on operator skill and attention. If your casting tolerances are loose (±2–3mm dimensional variation is acceptable) and you're not exporting to buyers who audit your process control records, manual systems work fine. If you need tighter consistency or ISO 9001 traceability, step up to mid-scale.

35–45 days Lead time
1 × 20ft Container
2–3 days On-site assembly

We provide 2 days of operator training during commissioning — enough to cover startup, normal operation, routine maintenance, and basic troubleshooting.

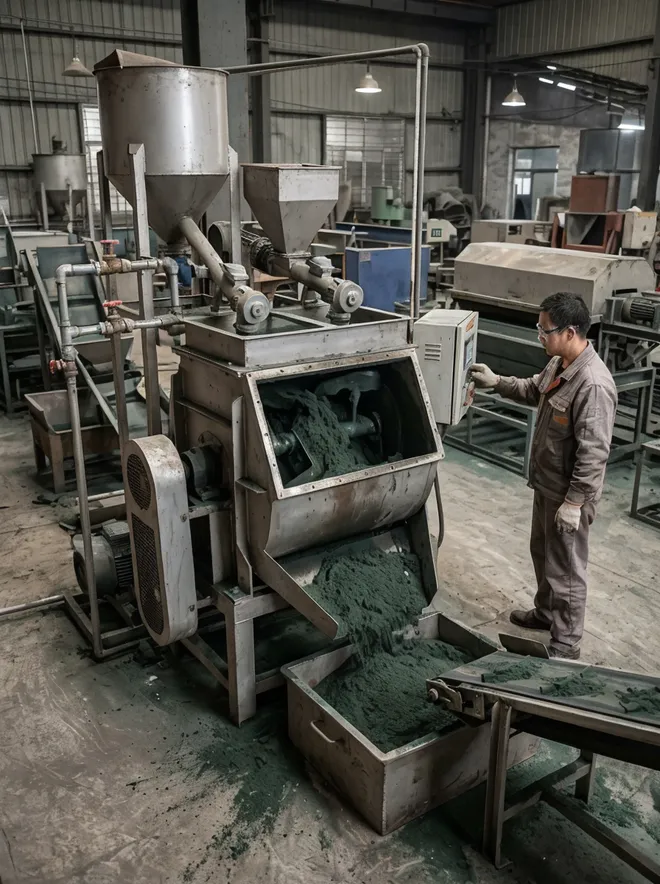

Small-scale clay sand preparation line with paddle batch mixer — 3 to 5 tons per hour configuration for foundries with intermittent molding schedules

Mid-Scale Configuration — 8–12 Tons/Hour

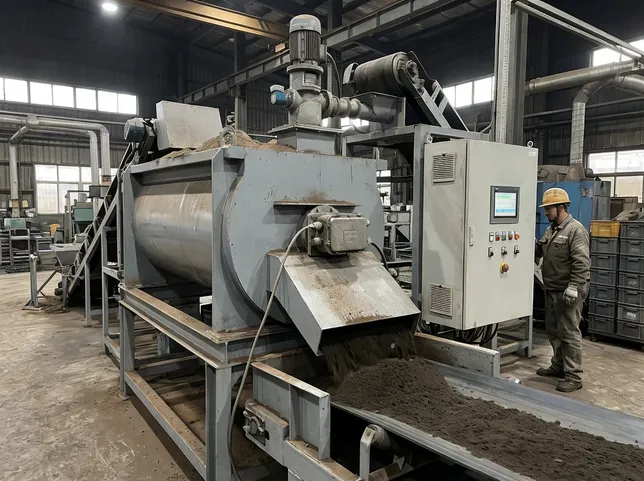

Mid-scale clay sand preparation line with PLC-controlled continuous mixer and moisture sensor at discharge point

PLC control enters at this tier — automated water injection driven by real-time moisture sensor feedback, PLC-controlled clay dosing from a screw feeder, and continuous mixing where sand flows through the mixer constantly rather than in batches. The moisture sensor sits at the mixer discharge and measures every ton of sand that exits. If moisture reads high, the PLC reduces the water injection rate on the incoming sand stream.

Response time is under 30 seconds, so the system self-corrects before you've produced more than 200–300 kg of off-spec sand.

Clay Content Control — Volumetric Screw Feeder

Clay content control uses a volumetric screw feeder driven by a variable-frequency drive. The PLC calculates the required clay addition rate based on sand throughput (measured by a belt scale on the input conveyor) and target clay percentage (set by the operator on the touchscreen).

Dosing Example

Throughput 10 tons/hour
Target Clay — 8% 800 kg/hour auto-dosed
Revised Target — 6% 600 kg/hour auto-adjusted
Operator Intervention None Required

Change the target clay percentage on the touchscreen and the clay feeder speed adjusts automatically — no operator intervention, no production pause.

Continuous Mixing Advantage

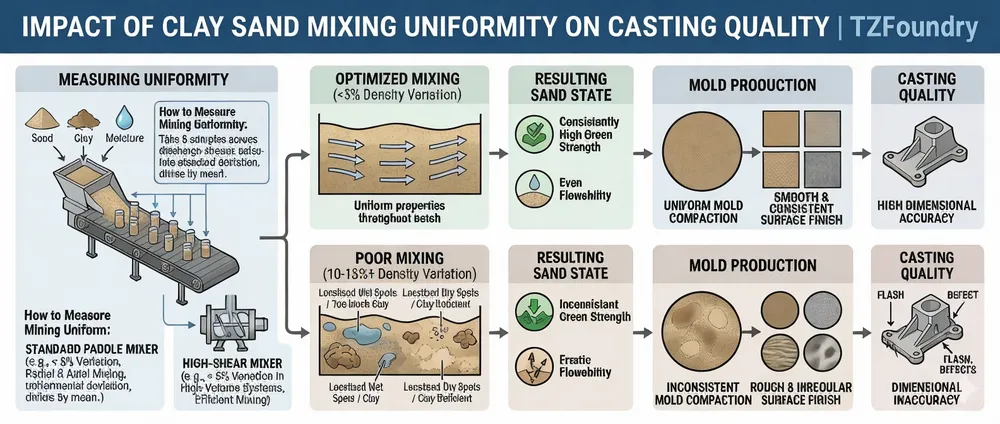

Continuous mixing produces better uniformity than batch systems — density variation drops to under 5% across the sand stream.

This translates directly to more consistent mold strength and permeability, reducing casting defects tied to sand property variation.

Full Process Data Logging

The PLC logs all process data — moisture, clay dosing rate, mixer speed, throughput — with timestamps for full traceability during quality audits.

Data exports to CSV or PDF for long-term archival or integration with your facility's quality management system.

Mid-Scale Physical & Operational Profile

Footprint

10m × 3.5m

Power Demand

30–45 kW

Operator Role

Monitor
not manual adjust

Shift Profile

2–3 shifts
3–8 formulations

Still one operator per shift, but their role shifts from manual control to monitoring — intervening only when the PLC flags an out-of-spec condition or when changing sand formulations for a different product. This configuration suits foundries running 2–3 shifts with moderate product variety (3–8 core sand formulations).

Upgrade Cost & Payback

Upgrade cost from small-scale to mid-scale runs about 60–70% more than the base system price.

Sand consistency improves → fewer mold defects.

Labor requirement drops — operator monitors rather than manually adjusts.

Process documentation ready for ISO 9001 or customer audits.

Most buyers recover the premium within 18–24 months of continuous operation through reduced scrap rates and lower labor cost per ton of prepared sand.

Lead Time & Commissioning

Factory Build

45–55 days

from deposit to factory departure

Shipping

1 × 40-ft Container

On-Site Assembly

3–4 days

PLC Commissioning + Training

2–3 days

PLC Interface Language

English default

Other languages on request — adds 1 week, no additional cost

High-Volume Configuration (15–20+ Tons/Hour)

Full automation with inline moisture and clay content sensors providing real-time feedback. The PLC adjusts water and clay dosing continuously — not just when readings drift out of tolerance — and the system includes predictive maintenance sensors on all rotating equipment: vibration monitors on mixer gearboxes, temperature sensors on motor bearings. This setup is built for foundries running 24/7 production with narrow product ranges (1–3 sand formulations that rarely change).

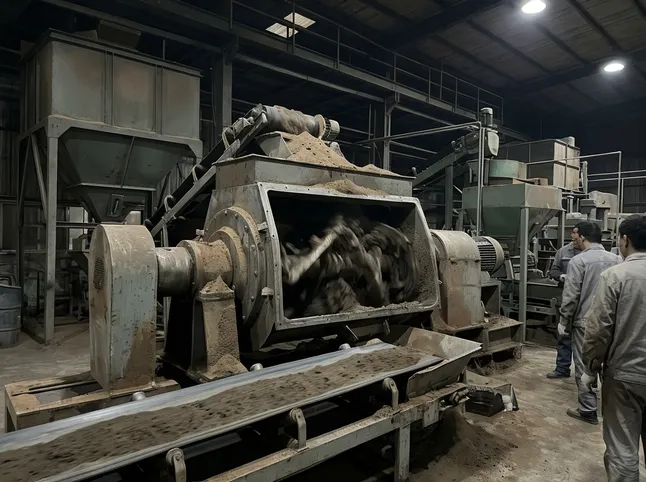

High-shear mixer operating at 60–80 RPM in a high-volume clay sand preparation configuration

High-Shear Mixer Upgrade

The mixer upgrades to a high-shear design running at higher speeds (60–80 RPM vs. 45 RPM for paddle mixers) and produces tighter mixing uniformity — density variation under 2% across the sand stream. This matters for thin-wall castings or precision work where mold surface finish directly affects casting dimensional accuracy.

High-shear mixing also improves clay activation (better bonding between clay particles and sand grains), which increases mold strength by 10–15% compared to paddle-mixed sand at the same clay content.

Path A
Reduce Clay Content

Use the 10–15% strength gain to lower clay dosing — saves on clay purchasing cost while maintaining equivalent mold performance.

Path B
Stronger Molds

Maintain the same clay content and get stronger molds — reduces breakage during handling and pouring for higher-yield production runs.

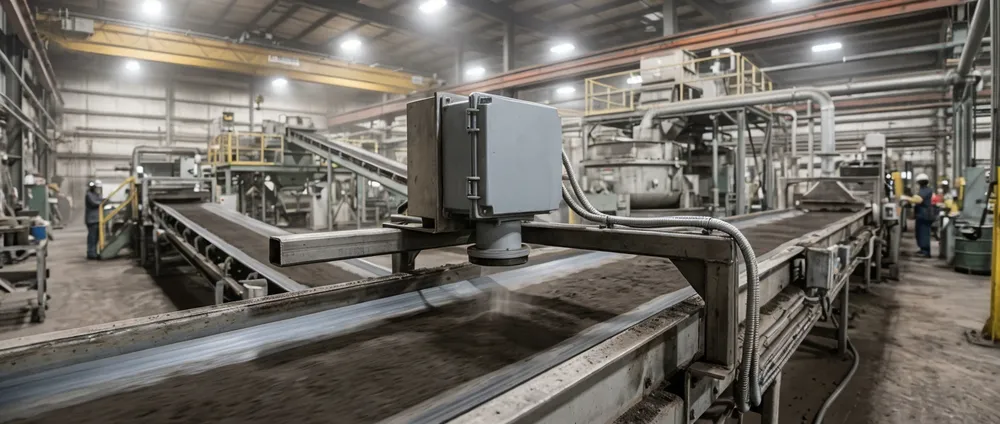

Optional Inline Clay Analyzer — Near-Infrared Spectroscopy

Standard systems rely on periodic lab testing — pull a sample every 2–4 hours, run a loss-on-ignition test, adjust clay dosing if needed. That means you're producing sand for 2–4 hours before you know if clay content is on target.

The inline analyzer gives you results every 10–15 seconds, so the PLC corrects clay dosing before you've made more than a few hundred kilograms of off-spec sand.

Standard Lab Testing 2–4 hr Detection-to-correction lag
Inline NIR Analyzer 10–15 sec Continuous real-time feedback
Investment: ~$8,000

If you're running high-value castings where a single bad mold costs more than the sensor, it's worth the investment. Eliminates the lag between detection and correction entirely.

Footprint 12m × 4m
Power Demand 60–85 kW
Staffing 1 per shift Monitoring & exception handling
Relative Cost 2.2–2.5× vs. small-scale system

Operator Role in Autonomous Mode

The system runs autonomously, but one operator per shift must be present for material replenishment, alarm response, and coordination with upstream/downstream equipment. This configuration is the only option that holds ±1% moisture and clay content across 12-hour shifts without manual intervention.

Predictive Maintenance Sensors

Vibration, temperature, and motor current data logs continuously to the PLC. When a bearing starts to wear or a motor draws excessive current — early signs of mechanical problems — the system flags a maintenance alert 24–48 hours before failure.

Without Predictive Sensors

Scrambling for parts when the mixer seizes up mid-shift. Unplanned downtime, expedited part shipping, and production schedule disruption.

With Predictive Sensors

Schedule bearing replacement during a planned maintenance window. Parts on hand, crew prepared, zero unplanned production loss.

Delivery, Assembly & Commissioning

Lead time is 50–60 days from deposit to factory departure. High-volume systems ship in one 40-foot high-cube container and require 4–5 days for on-site assembly plus 3–4 days for commissioning, calibration, and operator training. We send two technicians for commissioning (vs. one technician for smaller systems) because the inline sensors and predictive maintenance systems need more setup and validation time.

Lead Time

50–60 Days

From deposit to factory departure. Ships in one 40ft high-cube container.

On-Site Assembly

4–5 Days

Mechanical installation, electrical hookup, and alignment of all subsystems.

Commissioning & Training

3–4 Days

Calibration, sensor validation, predictive maintenance setup, and operator training — two technicians on-site.

Upgrade Path — Scale Without Full Replacement

If you start with a small-scale system and later need more capacity or better control, you can retrofit PLC control and continuous mixing without replacing the entire system. Most buyers who anticipate growth within 3–5 years start with mid-scale equipment sized for their future capacity rather than upgrading later.

Small → Mid-Scale

Retrofit PLC Control & Continuous Mixing

  • Costs approximately 50–60% of a new mid-scale system
  • Requires 1–2 weeks of downtime for retrofit
  • No need to replace the entire system — add PLC and continuous mixing modules

Good option if your current volume has grown moderately beyond initial projections.

Mid → High-Volume

Replace Mixer Assembly for High-Shear & Inline Sensors

  • Costs approximately 70–80% of a new high-volume system
  • Requires replacing the mixer assembly — significant intervention
  • Adds high-shear mixing and inline sensor capabilities

At 70–80% of new system cost, most buyers who anticipate this level of growth within 3–5 years start with mid-scale equipment sized for future capacity instead.

Planning Ahead? Size for Future Capacity Now.

If you anticipate growth within 3–5 years, starting with mid-scale equipment sized for your future capacity is more cost-effective than upgrading from a small-scale system later. The upgrade from mid-scale to high-volume (at 70–80% of new system cost) makes the economics of right-sizing at purchase time clear. Discuss your capacity roadmap with our engineering team to find the right starting point.

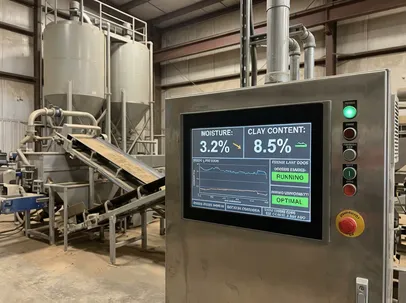

Quality Assurance

Quality Control Parameters — Moisture, Clay Content, Mixing Uniformity

Three parameters determine whether your prepared sand produces good molds or generates defects: moisture content (affects mold strength and workability), clay content (affects mold permeability and surface finish), and mixing uniformity (affects consistency across the batch).

Manual mixing systems struggle to hold tight tolerances on all three. PLC-controlled systems with inline sensors maintain ±1.5% on moisture and clay content, and under 5% density variation for mixing uniformity.

PLC control panel displaying real-time moisture and clay content readings for a clay sand preparation line

Moisture Content

Target 3–5% by weight

Affects mold strength, pattern release, and sand flowability into pattern details.

Clay Content

±1.5% PLC-controlled

Affects mold permeability and casting surface finish quality.

Mixing Uniformity

<5% density variation

Affects batch-to-batch consistency across the entire production run.

Moisture Content Control

Too Low Under 2.5%
  • Sand won't compact properly
  • Molds crumble during handling
  • Don't release cleanly from patterns
  • Incomplete mold surfaces from poor flowability
Target Range 3–5% by weight
  • Proper compaction for strong molds
  • Clean pattern release
  • Complete pattern detail filling
  • Consistent sand flowability
Too High Over 6%
  • Molds lose strength
  • Sag under their own weight
  • Crack when pouring molten metal
  • Clumping creates density variations

Capacitance Moisture Sensing & PLC Feedback Loop

Our mid-scale and high-volume systems use capacitance moisture sensors at the mixer discharge. The sensor measures the dielectric constant of the sand stream, which correlates directly to moisture content.

1

Commissioning Calibration

Sand samples at known moisture levels run through the sensor to build a calibration curve specific to your sand type and clay chemistry.

2

Real-Time Comparison

The PLC compares sensor readings to your target moisture setpoint and adjusts water injection rate in real time.

3

Automatic Correction

If moisture reads 4.8% and your target is 4.0%, water flow decreases. If moisture reads 3.2%, water flow increases. Response time: under 30 seconds from detection to correction.

Recalibration Interval

Every 3–6 months depending on sand type and clay chemistry changes.

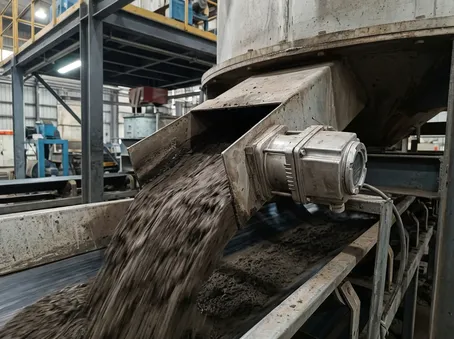

Capacitance moisture sensor installed at mixer discharge point measuring dielectric constant of clay sand stream

Manual Systems vs. PLC Moisture Control — The Drift Problem

Manual Monitoring
±3–5% moisture tolerance
  • Operators check moisture every 1–2 hours using handheld meters or lab tests
  • Moisture drifts between checks — off-spec sand produced for 1–2 hours before detection and correction
  • At 8 tons/hour, that's 8–16 tons of potentially off-spec sand per drift event
  • Off-spec sand in molds leads to cracks, poor surface finish, dimensional errors, and scrapped castings
PLC Automated Control
±1.5% moisture tolerance
  • Continuous inline capacitance sensing at mixer discharge
  • Real-time PLC comparison against target setpoint with automatic water injection adjustment
  • Under 30 seconds from detection to correction — virtually zero drift window
  • Every batch stays within ±1.5% of target moisture throughout the production run

Cost Impact of Moisture Variation

Real payback math from foundries that upgraded

10–15%

Reduction in mold-related defects after upgrading from manual (±3–5%) to PLC (±1.5%)

25 tons

Monthly scrap for 500 tons/month foundry at 5% defect rate

$72,000

Annual savings from 12% defect reduction at $2,000 avg casting value

3–4 months

Payback period on $15,000–$20,000 PLC moisture control premium

Worked example: A foundry producing 500 tons of castings per month with a 5% defect rate and $2,000 average casting value generates 25 tons of scrap monthly — $50,000 in lost revenue. Cutting defects by 12% saves $6,000/month or $72,000 annually. The equipment cost premium for PLC moisture control ($15,000–$20,000 over manual systems) pays back in 3–4 months.

Clay Content Control

Clay acts as the binder that holds sand grains together in the mold. Target clay content for most applications is 6–10% by weight — lower for castings that need high mold permeability (aluminum, bronze), higher for castings that need high mold strength (large iron castings, thin-wall parts). Too little clay (under 5%), and molds are weak and friable. Too much clay (over 12%), and molds have low permeability — gas from the molten metal can't escape, producing porosity defects in castings.

Mid-Scale Systems — Volumetric Screw Feeders

The PLC calculates required clay flow rate based on sand throughput (measured by a belt scale) and the operator's target clay percentage setpoint. At 10 tons/hour of sand with an 8% target, the system doses 800 kg of clay per hour.

The screw feeder's variable-frequency drive adjusts motor speed to maintain flow rate regardless of clay bulk density variations — clay compacts in storage silos over time, changing how much volume equals a given weight. The VFD compensates automatically.

Recommended

High-Volume Systems — Inline Clay Analyzer

An optional inline clay analyzer measures actual clay content using near-infrared spectroscopy. The sensor shines light at specific wavelengths through the sand stream and measures absorption — clay minerals absorb differently than quartz sand, revealing clay percentage in real time.

The PLC uses this real-time feedback to adjust clay dosing: if the analyzer reads 7.2% and your target is 8.0%, clay feeder speed increases. If it reads 8.6%, speed decreases.

Closed-loop accuracy: ±1% of target

Manual Systems — Volume-Based Dosing

Operators set a gate opening on a hopper or adjust a screw feeder's speed manually, then check actual clay content through lab tests every 4–8 hours.

The lag between production and test results means you're making sand for half a shift before you know if clay content is correct. If it's off by 2–3%, you've produced 16–24 tons of sand that might not meet mold quality requirements.

Open-loop accuracy: ±1.5–2% of target

Inline clay analyzer using near-infrared spectroscopy mounted on a clay sand preparation line conveyor, providing real-time clay content feedback to the PLC

Clay Content's Impact on Casting Quality

Molds with inconsistent clay content produce castings with variable surface finish and dimensional accuracy. The problem isn't the average — it's the variation within a production run.

6%
Low Clay Batch
  • Higher permeability — gas escapes easily, fewer porosity defects
  • Lower strength — more prone to erosion when molten metal hits the mold surface
10%
High Clay Batch
  • Stronger molds — better dimensional accuracy and surface finish
  • Traps gas — more porosity defects in finished castings

Key insight: If you're mixing low-clay and high-clay batches randomly throughout a production run, your defect rate stays high even though your average clay content is on target. Consistent clay content (±1–1.5% variation) produces consistent casting quality, which directly reduces scrap and rework costs.

Mixing Uniformity — Density Variation & Casting Impact

Even if moisture and clay content are correct on average, poor mixing creates localized variations — some portions of the batch are too wet or have too much clay, others are too dry or clay-deficient. This shows up as density variations when you measure sand samples from different points in the mixer discharge.

How to Measure Mixing Uniformity

Take six samples across the discharge stream, calculate standard deviation, divide by mean. Good mixing produces under 5% density variation. Poor mixing produces 10–15% variation or higher.

Standard Paddle Mixer

  • Speed: 45 RPM
  • Retention time: 90 seconds inside the mixer before discharge
  • Mixing pattern: Helical paddle arrangement creates both radial mixing (center → walls → center) and axial mixing (inlet → outlet with tumbling)
  • Density variation: < 5% for most sand types and clay contents

High-Shear Mixer (High-Volume Systems)

  • Speed: 60–80 RPM
  • Mixing intensity: Higher speed creates more intensive mixing action
  • Density variation: < 2% — significantly tighter uniformity
  • Trade-off: Power consumption increases 15–20% vs. standard paddle mixers
Diagram showing how sand density variation from mixer uniformity affects mold surface finish and dimensional accuracy in castings

Why Mixing Uniformity Directly Impacts Casting Quality

Poorly mixed sand creates density variations in the compacted mold. The mechanics are straightforward:

Denser Areas

  • → Harder, less permeable
  • → Resist erosion better during pour
  • → Good surface finish
  • → Compress less under compaction pressure

Less-Dense Areas

  • → Softer, more permeable
  • → Erode more during pour
  • → Rough surface finish
  • → Compress more under compaction pressure

The result: castings with inconsistent surface quality even though you're using the same sand formulation throughout. Dimensional accuracy suffers too — final mold dimensions can vary by 0.5–1 mm across the mold surface because denser and less-dense areas respond differently to compaction pressure.

Field Performance Data

20–30% Improvement in Surface Finish Consistency

Foundries that upgraded from low-speed mixers (30–35 RPM, common in older equipment) to our standard paddle mixers (45 RPM) report 20–30% improvements in casting surface finish consistency. The equipment cost difference is minimal — mixer motor and gearbox sizing — but the operational impact is significant: fewer castings rejected for surface defects, less secondary finishing work (grinding, polishing) to bring castings into spec.

20–30% surface finish
improvement
Total Cost of Ownership

Operational Cost Structure — Beyond the Purchase Price

Equipment acquisition is only the first line item. Energy consumption, clay additives, and retention efficiency determine your true per-ton cost of sand preparation.

Energy Consumption Per Ton of Prepared Sand

Energy consumption per ton of prepared sand runs 5–8 kWh in mid-scale systems and 6–9 kWh in high-volume configurations (high-shear mixers use more power but produce better uniformity). A mid-scale line processing 80 tons per day (10 tons/hour × 8-hour shift) consumes roughly 400–640 kWh daily.

At $0.12 per kWh (typical industrial rate in export markets), that's $48–77 per day or $1,440–2,310 per month in electricity cost. For perspective, that's $18–29 per ton of prepared sand in energy cost.

Energy Cost Snapshot

Mid-scale kWh/ton 5–8 kWh
High-volume kWh/ton 6–9 kWh
Daily (80 t/day) 400–640 kWh
Monthly electricity $1,440–$2,310
Energy cost/ton $18–$29

Where the Energy Goes

50–60%

Mixer Motor

Largest single load

30–40%

Conveyor Motors

Material transport

~10%

PLC, Sensors & Dust Collection

Controls & auxiliary

High-Shear vs. Paddle Mixer — The Energy–Quality Trade-off

If energy cost is a major concern in your market, focus on mixing efficiency. High-shear mixers use 15–20% more power than paddle mixers but produce tighter uniformity, which reduces downstream defects. The energy cost increase is $3–5 per ton, but if better uniformity cuts your casting defect rate by even 2–3%, the scrap cost savings exceed the energy cost increase by 5–10×.

Clay sand preparation line mixer and conveyor motors — primary energy consumers in sand conditioning systems

Clay Additives — Your Largest Consumable Expense

Clay addition rate depends on your target clay content and how much clay you're losing to waste (dust collection, spillage, degradation). At 8% target clay content with 95% clay retention (5% lost to dust and spillage), you're adding roughly 8.4 kg of fresh clay per ton of prepared sand.

An 80-ton-per-day operation uses 672 kg of clay daily, or 20 tons monthly. Bentonite clay costs vary by region and grade, but budget $200–350 per ton delivered — so $4,000–7,000 per month in clay purchases. That's $50–88 per ton of prepared sand in clay cost.

Clay Cost Snapshot (80 t/day)

Target clay content 8%
Retention rate 95%
Fresh clay/ton sand 8.4 kg
Daily clay usage 672 kg
Monthly clay usage ~20 tons
Bentonite cost/ton $200–$350
Monthly clay spend $4,000–$7,000
Clay cost/ton sand $50–$88

Clay vs. Energy — Relative Cost Weight

Clay cost per ton of prepared sand is your largest consumable expense — typically 3–5× higher than energy cost. This makes clay retention the single most impactful lever for reducing ongoing operational cost.

Energy cost/ton

$18–$29

Clay cost/ton

$50–$88

3–5× energy cost

Clay Retention Payback — Enclosed Conveyors & Dust Collection

Systems with enclosed conveyors and effective dust collection retain 95–98% of dosed clay. Open conveyors or poor dust collection drop retention to 85–90%, meaning you buy 10–15% more clay to achieve the same clay content in the prepared sand.

The equipment cost for enclosed conveyors and dust collection is about $5,000–8,000, but it saves $500–1,000 per month in clay purchases for a typical mid-scale operation — payback in 6–10 months.

Water Usage

Water consumption runs 30–50 liters per ton of prepared sand, mostly for moisture addition in the mixer. An 80-ton-per-day operation uses 2,400–4,000 liters daily. If you're on municipal water, that's negligible cost — $2–5 per day in most markets.

If you're trucking water or operating in a water-scarce region, consider the closed-loop water recycling option. It captures water from the mixer's dust collection system (water vapor condenses in the dust collector), filters out suspended solids, and returns clean water to the mixer's spray nozzles.

The recycling module costs about $8,000–10,000 and cuts water consumption to 3–5 liters per ton (only makeup water to replace evaporation losses). Payback depends on your local water cost, but in water-scarce regions where trucked water costs $50–100 per cubic meter, the recycling system pays back in 3–6 months.

Water Consumption Comparison
Standard Operation 30–50 L/ton

80 t/day = 2,400–4,000 L daily

With Recycling Module 3–5 L/ton

~90% reduction in water use

Recycling module: $8,000–10,000

Payback (water-scarce): 3–6 months

Closed-loop water recycling module integrated with clay sand mixer showing condensation capture and filtration return loop

Closed-loop water recycling module — captures condensate from dust collection, filters suspended solids, and returns clean water to mixer spray nozzles.

Maintenance Consumables

Ongoing consumable costs center on three wear items: mixer paddles, moisture sensors, and belt conveyors. Here's what each costs and how often replacement is needed.

Mixer Paddles

  • Silica sand @ 45 RPM: 6–12 months
  • Chromite sand (more abrasive): 3–6 months
  • Replacement set: $200–400
  • Installation: 2–3 hours, no special tools

Annual budget (mid-scale, 1 shift):

$400–800/year

Moisture Sensors

  • Calibration interval: every 3–6 months
  • Calibration time: 1–2 hours with reference sand samples
  • Outsourced calibration: $150–250/visit
  • Sensor replacement: $300–500 every 3–5 years

Calibration kit included with each system. More frequent calibration needed when switching sand types or clay formulations.

Belt Conveyors

  • Belt replacement: every 2–3 years
  • Replacement belt: $150–300 per conveyor
  • Typical system: 2–3 conveyors
  • Belt install time: 3–4 hours

Rollers & bearings: $200–400/conveyor, last 5–7 years

Annual Consumables Budget — Mid-Scale, Single-Shift Operation

Cost Summary

Mixer Paddles

$400–800

per year

Sensor Calibration

$300–500

per year (outsourced, 2 visits)

Belt Replacement

$150–450

annualized (2–3 yr cycle)

Total Estimate

$850–1,750

per year

Labor Requirements

Small-Scale Systems

One operator per shift to set moisture and clay targets, monitor batch quality, and adjust parameters between batches.

Skill level: Foundry experience required, but no specialized training needed. TZFoundry provides 2 days of on-site instruction during commissioning.

Mid-Scale & High-Volume (PLC-Controlled)

One operator per shift for monitoring and exception handling — the PLC runs the system autonomously. Operator presence required for:

  • Material replenishment — refilling clay silos, clearing conveyor jams
  • Alarm response — sensor faults, out-of-spec conditions
  • Coordination with upstream/downstream equipment

Skill level: Operators need to navigate touchscreen interfaces, interpret alarm codes, and adjust setpoints — basic HMI operation, not advanced programming. If your team lacks this background, plan for 2–3 extra days of training.

Operator Training Track Record

TZFoundry has trained operators with no prior PLC experience in 4–5 days total: 2 days during commissioning + 2–3 days of follow-up remote support via video calls.

Total Cost Per Ton of Prepared Sand

For a mid-scale system running 80 tons per day (one 8-hour shift), typical operating costs break down as follows:

Cost Category Range Per Ton
Energy $18–29
Clay Additives $50–88
Water $0.05–0.10
Maintenance Consumables $1–2
Labor $15–25
Total Operating Cost $84–144

Equipment Amortization

Purchase price amortizes to $3–6 per ton over a 10-year service life, assuming $200,000 equipment cost and 240,000 tons total production. This adds only a small fraction to the per-ton operating cost.

Controlling Your Largest Cost Variables

#1 Variable

Clay Cost

The largest variable you control. Two levers directly reduce clay expenditure:

Better dust collection improves clay retention and saves 5–10% on clay purchasing costs.

Reducing target clay content from 9% to 7% saves $11–20 per ton in clay cost — but only if your molds still meet strength requirements at lower clay content.

#2 Variable

Defect-Related Waste

The second-largest variable. Better moisture and clay control directly impacts your bottom line through yield improvement:

If improved sand preparation cuts your casting defect rate by 10%, you produce 10% more saleable castings from the same amount of prepared sand.

This effectively reduces your sand cost per good casting by 10%.

Tailored to Your Foundry

Customization & Integration Flexibility

Standard clay sand preparation lines cover 3–20 tons per hour capacity, 6–10% clay content range, and 3–5% moisture range. If your operation falls outside those parameters, or if you're integrating with non-standard equipment, we modify the base design to fit your requirements.

Mixer Capacity Adjustments

Systems built from 2 t/h for pilot foundries up to 25 t/h for high-volume operations.

Control System Options

Manual, semi-automatic PLC, or full-automatic with inline sensors — matched to your operational maturity.

Material Compatibility

Different clay types, alternative binders, and specialty sands accommodated through design modifications.

Conveyor Interface Configs

Custom discharge heights, non-standard belt widths, pneumatic transport instead of belt conveyors.

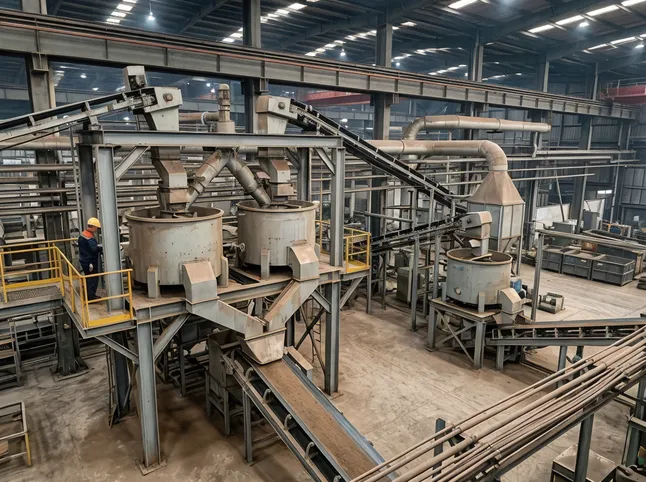

Clay sand preparation line mixer capacity configurations — standard paddle mixers and dual parallel mixer setups for different tonnage requirements

Mixer Capacity Range

Our standard paddle mixers scale from 3 to 20 tons per hour by changing mixer chamber volume and paddle configuration. Outside that standard band, we offer two purpose-built approaches:

Below 3 t/h

Smaller mixer design rated 1.5–2.5 tons per hour, purpose-built for low-volume and pilot foundries.

~30% less cost vs. standard 3 t/h mixer

Uses the same control system and conveyor components as the standard line — no separate parts inventory required.

Above 20 t/h

Dual parallel mixers (two 12–15 t/h units) feeding a common discharge conveyor — rather than building a single oversized mixer.

15–20% less cost vs. single 25 t/h mixer

Built-in redundancy: if one mixer needs maintenance, the other keeps running at reduced capacity.

Not Sure What Capacity You Need?

Calculate based on your molding line's consumption rate plus 20% buffer:

(molds/hour) × (sand per mold in kg) × 1.2 ÷ 1,000 = capacity in t/h

Example Calculation

100

molds/hour

30 kg

sand per mold

1.2×

buffer factor

Required capacity:

3.6 t/h

Recommendation: a 4–5 t/h system to provide comfortable margin for production rate variations and future growth.

Control System Options

Choosing the right control architecture depends on your throughput target, quality tolerance, and whether you need traceability documentation. Three tiers cover the full range.

Tier 1

Manual Control

  • Operator-set water valves and clay feeders — no PLC
  • Best for operations under 5 tons/hour
  • Loose quality requirements acceptable
Lowest capital cost
Tier 2

Semi-Automatic PLC

  • PLC-controlled water injection and clay dosing
  • Moisture sensor feedback loop — no inline clay analyzer
  • Suits 5–15 tons/hour with moderate quality requirements
Mid-range investment
Recommended
Tier 3

Full-Automatic PLC

  • Inline moisture and clay sensors with auto-adjustment
  • Data logging and SCADA integration
  • For 10+ tons/hour with tight quality requirements or ISO 9001 traceability
Highest ROI at scale

Modular Upgrade Path — Start Simple, Scale Later

Control system upgrades are modular. If you start with manual control and later need PLC automation, we retrofit the control system without replacing mechanical components.

40–50% of the price difference between manual and PLC — you pay for PLC hardware, sensors, and commissioning labor, not re-engineering
3–5 days total downtime for retrofit — mechanical design stays untouched
0 mechanical components replaced — electrical/sensor additions only

Material Compatibility

Our standard clay sand preparation line handles the most common foundry materials out of the box. Non-standard materials require targeted adjustments — all addressed during the quotation phase.

Standard Configuration Covers

Material Role
Sodium bentonite clay Most common foundry binder
Silica sand Most common molding sand
3–5% target moisture Standard moisture range
Various foundry sand and clay materials handled by TZFoundry preparation lines

Material-Specific Adjustments

Calcium Bentonite

Activates slower than sodium bentonite — requires adjusted mixer retention time.

Sodium bentonite 90 sec
Calcium bentonite 120–150 sec
Chromite / Zircon Sand

Denser and more abrasive than silica — mixer paddles upgraded to hardened steel or ceramic-coated steel.

Paddle upgrade cost $300–500
Paddle lifespan gain 2–3× longer
Alternative Binders

Seacoal, cereal binders, or synthetic resins may require different mixing speeds or water injection patterns.

Specify your binder during quotation so we can engineer the correct mixing profile.

Specialty Applications We've Handled

Low-Clay

3–4% clay content

For aluminum casting — requires high-shear mixer for adequate clay activation at low concentrations.

High-Clay

12–15% clay content

For large iron castings — requires oversized clay feeders to handle higher volumes of binder material.

Dual-Binder

Clay + seacoal or clay + resin

Requires separate dosing systems for each binder — independent feed rate control and mixing sequencing.

Cost impact: Specialty application customizations add 15–30% to base system cost depending on complexity. The exact premium is quoted after reviewing your material specifications, throughput requirements, and quality targets.

Conveyor Interface Customization

Discharge Height Range

Standard: 1,200mm above floor level

Systems built from 800mm (feeding into low-profile molding lines) to 2,500mm (feeding into elevated storage hoppers). Height flexibility ensures compatibility with virtually any existing foundry floor plan.

Cost Impact

  • Adjustments under 500mm from standard — no added cost (support frame change only)
  • Adjustments over 500mm — structural modifications required (taller frames, additional bracing): $2,000–$4,000

Belt Width & Transport Type

Standard: 400mm or 500mm belt

If your equipment uses 300mm, 600mm, or other widths, TZFoundry matches it. For foundries using pneumatic transport or screw conveyors instead of belt conveyors, the mixer discharge is configured with a drop chute and rotary valve interface.

Cost Impact

  • Belt width changes: $500–$1,000 per conveyor
  • Pneumatic/screw conveyor interface (drop chute + rotary valve): $3,000–$5,000 depending on conveyor type and capacity
TZFoundry clay sand preparation line conveyor interface showing adjustable discharge height and belt width configurations

Conveyor discharge configurations — height range 800mm to 2,500mm, belt widths from 300mm to 600mm

Integration with Existing Equipment

Most integration challenges involve two categories: control signal compatibility (your molding line uses one PLC brand, TZFoundry uses another) and mechanical interface mismatches (conveyor heights, belt speeds, hopper inlet sizes).

Control Signal Compatibility

TZFoundry provides relay interfaces or protocol converters that translate between different PLC communication standards — bridging any brand mismatch between your existing molding line and the new preparation system.

Integration Cost

$1,500 – $3,000

Depending on protocol complexity

Mechanical Interface Matching

Conveyor configurations are adjusted during the design phase based on photos and measurements you provide of your existing equipment — conveyor heights, belt speeds, and hopper inlet sizes are all resolved before fabrication begins.

What You Provide

Photos + dimensions of current equipment during quotation phase

Replacing an Older System? Reuse What You Can.

When replacing an older preparation system, TZFoundry can often reuse your existing sand storage silos, clay storage, and some conveyor sections. This approach reduces total project cost by 15–25% and simplifies installation — less demolition and rigging work required.

Send photos and dimensions of your current equipment during the quotation phase, and TZFoundry engineers will identify which components are reusable and factor the savings into your project proposal.

MOQ & Lead Time Impact

Single-System Orders

No MOQ

No minimum order quantity for complete systems — some manufacturers won't quote unless you're buying 3+ lines. Single-system orders ship in 45–60 days from deposit to factory departure.

Multi-System Orders (2–3 Lines)

Volume Savings

Common for buyers setting up new foundries or expanding existing facilities. Lead time extends to 55–70 days, but per-unit cost drops by 8–12% because we're building multiple units in parallel and amortizing engineering and setup costs across the order.

Customization Lead Time Breakdown

No Added Lead Time
  • Motor voltage changes — we stock 380V, 415V, and 460V motors
  • PLC interface language — English, Spanish, Portuguese, Russian, Arabic available without delay
  • Paint color — standard industrial gray in stock; custom RAL or Pantone colors applied at no cost
Adds 1–2 Weeks
  • Non-standard mixer capacities — requires custom paddle fabrication
  • Specialty materials — stainless steel components for corrosive environments
  • Third-party component integration — if you specify a particular sensor brand or PLC model we don't normally stock
TZFoundry clay sand preparation line systems staged in factory — single and multi-unit production batches showing parallel build capacity
Maintenance & Consumables

Maintenance & Consumables

Routine maintenance follows a tiered schedule: daily checks (5–10 minutes), weekly inspections (30–45 minutes), monthly servicing (2–3 hours), and quarterly overhauls (4–6 hours). Daily tasks can be handled by production operators with basic mechanical aptitude. Weekly and monthly tasks need a maintenance technician. Quarterly overhauls benefit from having our remote support available via video call, but most buyers handle them in-house after the first year of operation.

Daily

5–10 min / shift

Production operators with basic mechanical aptitude

Weekly

30–45 min

Maintenance technician required

Monthly

2–3 hours

Maintenance technician required

Quarterly

4–6 hours

Remote video call support available; most buyers self-handle after year one

Daily Maintenance (5–10 minutes per shift)

Check mixer gearbox oil level

Sight glass on gearbox housing — oil should be between min/max marks. A dry gearbox seizes within 2–4 hours of operation.

Lubricate conveyor roller bearings

Grease fittings at each roller — 2–3 pumps of grease per fitting.

Inspect conveyor belts for damage or misalignment

Look for frayed edges, belt tracking off-center. A misaligned belt can tear and halt production mid-shift.

Verify moisture sensor is clean

Wipe sensor face with dry cloth if sand buildup is visible.

80% of unplanned downtime is preventable with these daily checks. A dry gearbox seizes within 2–4 hours, and a misaligned belt can tear and halt production mid-shift.

Operator checking mixer gearbox oil level on clay sand preparation line — sight glass inspection during daily maintenance routine

Weekly Maintenance (30–45 minutes)

Inspect Mixer Paddles for Wear

Measure paddle thickness at three points — replace when thickness drops below 80% of original. This catches wear before it causes failures or degrades mix quality.

Check Belt Tension on All Conveyors

Press belt midway between rollers — deflection should be 10–15mm under moderate finger pressure. Proper tension prevents slippage and premature wear.

Verify Clay Feeder Screw Is Clear

Remove inspection cover, check for bridging or caked material. Blockages in the clay feeder disrupt mix ratios and create inconsistent sand quality.

Test Moisture Sensor Calibration

Run a known-moisture sand sample through the system, compare sensor reading to lab test result — recalibrate if difference exceeds 0.5%. Weekly calibration verification keeps moisture control within the ±1.5% specification.

Monthly Maintenance Protocol — 2–3 Hours

Monthly servicing maintains system performance and prevents gradual degradation. Plan for 2–3 hours of technician time on each task set below.

Mixer Gearbox Oil Change

  • Drain via bottom plug, refill with ISO VG 320 gear oil
  • Capacity: 8–12 liters depending on mixer size
  • Interval: every 3 months — cost $80–120 per change (oil + labor)

Moisture Sensor Calibration

  • Use calibration kit with three reference samples (low / mid / high moisture levels)
  • Full calibration: monthly check, annual recalibration (1–2 hours labor, no parts cost)
  • Sensor replacement every 3–5 years — cost $300–500 per unit

Electrical Connection Inspection

  • Check for loose terminals, signs of overheating
  • Inspect for damaged insulation and discolored wiring
  • Prevents unplanned downtime from electrical faults

Dust Collector Filter Cleaning

  • Remove cartridges, shake out accumulated dust, reinstall
  • Replace if fabric is torn or clogged beyond cleaning
  • Filter cartridge set: $100–150 — lasts 12–18 months with monthly cleaning

Quarterly Maintenance Protocol — 4–6 Hours, Production Shutdown

Quarterly overhauls are scheduled during low-volume periods or between shifts to minimize production impact. Requires a planned production shutdown of 4–6 hours.

1

Replace Mixer Paddles (If Wear > 20%)

Unbolt worn paddles, bolt on new set. 8–12 paddles per mixer depending on size. Inspect paddle mounting bolts for thread damage during replacement.

2

Conveyor Belt Tracking Adjustment

Loosen belt tension, adjust roller alignment, retighten. Belt should run centered on rollers with no edge contact. Misaligned belts accelerate edge wear and can cause material spillage.

3

Clay Feeder Seal Replacement

Screw feeder shaft seals prevent clay dust from entering bearings. Seals last 6–12 months depending on clay abrasiveness — shorter life with fine-grind clay that generates more dust.

4

Full PLC Backup

Export program and data logs to USB drive for archival. Ensures recipe configurations and tuning parameters are recoverable after any controller failure.

Quarterly maintenance — mixer paddle inspection and replacement on a TZFoundry clay sand preparation line

Consumable Costs & Replacement Intervals

Mixer paddles are the highest-wear component in any clay sand preparation line. Choosing the right paddle material directly controls your annual consumable spend and shutdown frequency.

Paddle Material Service Life Cost per Set (8–12 paddles) Best For
Standard Carbon Steel 6–12 months $200–400 Silica sand service — most common choice, replaced annually during planned shutdown
Hardened Steel 12–18 months $350–600 Abrasive sands — chromite, zircon, and other specialty casting sands
Ceramic-Coated 18–24 months $500–800 Extreme abrasion resistance — longest life, lowest shutdown frequency

Other Key Consumables

Moisture Sensors

Replace every 3–5 years

$300–500 per unit

Clay Feeder Seals

Replace every 6–12 months

$50–100 per set

More frequent with fine-grind clay

Conveyor Belts

Replace every 2–3 years

$150–300 each

Dust Collector Filters

Replace every 12–18 months

$100–150 per set

Replace sooner if processing very dusty sand or filters get wet

Total Annual Consumable Cost (Mid-Scale System)

$800–$1,500 depending on usage intensity and sand abrasiveness

Includes paddles, seals, filters, belts, oil, and sensor maintenance. Excludes labor.

Spare Parts Availability

We stock high-wear components — mixer paddles, conveyor belts, moisture sensors, clay feeder seals — at our Qingdao facility and ship via DHL or FedEx for 5–7 day delivery to most export markets.

For longer-lead items (mixer gearboxes, motors, PLC controllers), we recommend keeping one spare on-site if downtime risk is critical to your operation. The cost is 5–8% of original equipment price, but it eliminates the risk of a 2–3 week production shutdown waiting for a replacement part to clear customs and ship.

TZFoundry spare parts warehouse showing stocked mixer paddles, conveyor belts, and moisture sensors for clay sand preparation line maintenance

Recommended On-Site Spare Parts Kit

These parts cover 90% of unplanned maintenance scenarios and can be installed by your maintenance team without waiting for factory support.

Component Qty Estimated Cost
Mixer paddles 1 set $200–400
Moisture sensor 1 unit $300–500
Clay feeder seals 2 sets $100–200 total
Conveyor belt (per conveyor) 1 each $150–300 each
Total Kit Investment (mid-scale system) $750–1,400

Remote Diagnostics & Support

Our PLC systems include VPN capability for remote troubleshooting. When you report a problem — inconsistent moisture, clay dosing errors, sensor faults — we log into your PLC via secure connection and review the last 48–72 hours of process data, identify parameter drifts or equipment faults, and walk your team through the fix over a phone or video call. This cuts troubleshooting time from days (waiting for a technician to travel to your facility) to hours.

1

You Report the Issue

Describe the symptom — moisture drift, dosing error, sensor fault — via phone, email, or WeChat.

2

Secure VPN Diagnostic

We access your PLC in read-only mode by default — viewing data and downloading logs without changing setpoints or controlling equipment unless you grant write access.

3

Guided Resolution

Your technician makes the physical repairs or adjustments while we provide real-time diagnostic support via video call.

Response Times

China business hours (UTC+8): 4–8 hours remote support response

Outside business hours: 12–24 hours for inquiries submitted outside that window

On-Site Service Fallback

If remote support doesn't resolve the problem, we dispatch a technician for on-site service. Cost structure:

  • Travel costs (airfare, accommodation) — covered by buyer
  • Labor — covered by TZFoundry

On-site service is rare after the first year of operation — most buyers need it 0–1 times per year for major component replacements or capacity upgrades.

Manufacturer Background

Why TZFoundry Clay Sand Preparation Lines

Building Clay Sand Preparation Equipment Since 2010

We've been building clay sand preparation equipment since 2010, starting with standalone mixers for domestic foundries and moving to integrated preparation lines when export buyers needed systems that connected to their existing molding equipment without custom engineering on their end.

The shift happened because overseas buyers don't want to coordinate between multiple equipment suppliers — they need one manufacturer who understands the full integration picture and delivers a system that works with what they already own.

TZFoundry clay sand preparation line manufacturing workshop — integrated system assembly

In-House R&D — No Outsourced Design Work

Our in-house R&D team handles custom configurations without outsourcing design work to third-party engineering firms. When you need a non-standard mixer capacity, a different control system, or integration with unusual upstream/downstream equipment, we're modifying our own designs — not coordinating between multiple vendors who each have their own lead times and compatibility issues.

This matters most when you're adapting a preparation line to fit an existing foundry layout with space constraints or utility limitations.

Real Custom Engineering Examples

Compact Floor Space Adaptation

Built systems that fit 8m × 3m floor spaces where the standard spec calls for 10m × 3.5m — a layout-driven redesign, not just component rearrangement.

Non-Standard Voltage Configuration

Systems running on 380V three-phase power instead of the standard 415V — because that's what the buyer's facility provided.

Certifications & Quality Audit Trail

ISO 9001:2015

Annual third-party audits verifying documented procedures for material sourcing, fabrication, assembly, and testing.

CE Certified

Conformity with European health, safety, and environmental protection standards for equipment export.

SGS Certified

Independent inspection and verification from a globally recognized testing authority.

Why This Matters for Your Supply Chain

The certifications themselves don't make the equipment better, but they create a paper trail that satisfies your own quality audits and customer requirements. If you're selling castings to automotive or aerospace buyers who require supplier traceability, you'll need to show that your foundry equipment came from a certified manufacturer. We provide the complete documentation package — material certs, test reports, calibration records — with every system shipment.

Production Capacity & Lead Time Stability

Our facility runs 8 production lines across 15,000 square meters, producing 500,000 units annually. That capacity matters because it determines lead time stability — we're not a job shop that gets backlogged when a large order comes in.

A typical clay sand preparation line order (mid-scale configuration) consumes about 2–3 weeks of production time across multiple lines (frame fabrication, machining, electrical assembly, testing). We can run 4–6 systems in parallel, so even if we have a queue of orders, your lead time stays in the 45–60 day range.

8

Production Lines

15,000

Sq. Meters Facility

4–6

Parallel Systems

45–60

Day Lead Time

Flexible MOQ & Customization Services

We don't have a minimum order quantity for complete systems, and we'll modify standard designs without charging engineering fees — unless the changes require new tooling or outside components.

No Additional Cost
  • Different motor voltages
  • PLC interface language changes
  • Custom paint colors
  • Conveyor height adjustments under 500 mm
Adds Cost
  • Non-standard mixer capacities (custom paddle fabrication)
  • Special materials for corrosive environments (stainless steel instead of carbon steel)
  • Third-party component integration (specific brand of PLC or sensor not normally stocked)
Customized clay sand preparation line being assembled at TZFoundry factory — modified motor and conveyor configurations

Professional Export Experience

We handle documentation, shipping logistics, and customs coordination as part of the standard service. We've shipped to 40+ countries and know which markets require specific certifications, what information customs officials need on commercial invoices, and how to pack equipment to survive ocean freight without damage.

CE Europe
GOST Russia
SASO Saudi Arabia

Standard Documentation (Every System)

  • English-language operations manual
  • Electrical schematics
  • Spare parts list
  • Maintenance schedule

Additional Language Translation

$500–800 depending on language & document length

Adds 1–2 weeks to delivery. Available for any language — we arrange professional technical translation of the full documentation package.

Engineer-to-Engineer Answers

FAQ — Technical Decision Questions

Practical answers to the engineering and operational questions foundry teams ask most when evaluating clay sand preparation line investments.

What causes inconsistent sand moisture in clay sand preparation lines?

Three common causes:

1 Inadequate Water Flow Control

Manual valves that operators adjust by hand drift over time as valve seats wear, causing unpredictable water delivery to the mixer.

2 Worn Mixer Paddles

Reduced mixing intensity means water doesn't distribute evenly through the sand mass, creating wet and dry pockets in the batch.

3 Ambient Humidity Variation

Sand absorbs or releases moisture between the mixer and molding line if storage time is long, shifting the prepared moisture level.

Targeted Solutions

  • PLC control with inline moisture sensors solves the first problem — the system measures actual moisture at the mixer discharge and adjusts water injection automatically, compensating for valve wear and flow variations.
  • Replacing worn paddles (when thickness drops below 80% of original) solves the second problem, restoring full mixing intensity.
  • Reducing storage time between preparation and molding (use smaller buffer hoppers, increase preparation frequency) solves the third problem.

Still seeing moisture variation despite PLC control and good paddle condition?

Check your water supply pressure — if facility water pressure fluctuates (common in facilities with multiple high-demand users on the same supply line), the PLC's flow control valve can't maintain consistent water injection even with correct control signals. Install a pressure regulator on the water supply line to the preparation system (costs $300–500, maintains constant pressure regardless of facility demand).

How often should clay sand preparation equipment be calibrated?

Component Frequency Procedure & Notes
Moisture Sensors Every 3–6 months More often if switching between different sand types or clay formulations. Takes 1–2 hours using reference sand samples at known moisture levels — calibration kit provided with each system.
Clay Feeders Every 6–12 months Run the feeder at a set speed for 5 minutes, weigh the discharged clay, compare to expected weight based on feeder specifications. Adjust the PLC's calibration factor if the difference exceeds 5%.
Mixer Speed (RPM) Annually Verify using a tachometer — if actual speed differs from setpoint by more than 3%, check for belt slippage or motor controller issues.
Belt Scales Every 3 months Requires certified test weights. Most buyers outsource to industrial weighing service companies ($200–300 per visit) because it requires traceable calibration weights and documentation for quality system compliance.

Screw conveyors and volumetric feeders used for clay delivery follow the same 6–12 month calibration cycle. The 5-minute discharge-and-weigh test is a straightforward procedure your maintenance team can perform in-house without specialized equipment.

Paddle mixer vs. high-shear mixer for clay sand preparation: which is better?

Paddle mixers work for standard clay content (6–10%) and moderate uniformity requirements (under 5% density variation). They run at 45 RPM, consume less power (30–45 kW for mid-scale systems), and cost less ($40,000–60,000 for a complete mid-scale system). High-shear mixers are for low clay content (under 5%, where clay activation is critical) or tight uniformity requirements (under 2% density variation for precision casting work). They run at 60–80 RPM, consume more power (50–70 kW for equivalent capacity), and cost more ($55,000–80,000 for a complete mid-scale system).

Parameter Paddle Mixer High-Shear Mixer
Clay Content Range 6–10% (standard) Under 5% (activation-critical)
Density Variation Under 5% Under 2%
Speed 45 RPM 60–80 RPM
Power Consumption 30–45 kW (mid-scale) 50–70 kW (mid-scale)
System Cost (Mid-Scale) $40,000–60,000 $55,000–80,000

Operational trade-off: High-shear mixers produce 10–15% stronger molds at the same clay content (better clay activation means better bonding), which lets you either reduce clay content (saves on clay purchasing cost) or maintain the same clay content and get stronger molds (reduces breakage during handling and pouring). If your casting defect rate is high due to mold strength issues, the high-shear mixer's cost premium pays back through reduced scrap. If your molds are already meeting strength requirements with paddle mixing, there's no operational benefit to upgrading.

Can a clay sand preparation line handle both fresh and reclaimed sand?

Yes, dual-input systems mix fresh and reclaimed sand in controlled ratios. The typical configuration uses two input conveyors (one from fresh sand storage, one from the reclamation system) that merge onto a common belt scale before entering the mixer. The PLC controls the feed rate from each conveyor to maintain your target blend ratio — common split is 70% reclaimed, 30% fresh for most gray iron and ductile iron work. The mixer treats the blended sand as a single input stream and adds clay and water based on total throughput.

Clay Addition Calculation

Reclaimed sand typically has 2–4% residual clay content (clay that survived the reclamation process), so your fresh clay addition rate needs to account for that. If you're targeting 8% final clay content and your reclaimed sand has 3% residual clay, you're adding 5% fresh clay to the blend (not 8%). The PLC calculates this automatically if you input the reclaimed sand's residual clay percentage as a parameter.

Caution — variable reclaimed sand quality: If your reclaimed sand quality varies significantly batch-to-batch (residual clay content swings by 2–3%), you'll see corresponding variation in final prepared sand quality unless you add an inline clay analyzer (measures actual clay content in the prepared sand and adjusts fresh clay dosing to compensate). The analyzer costs $8,000 but eliminates the guesswork when working with variable-quality reclaimed sand.

What is the minimum production scale for automated clay sand preparation?

8–10 tons per hour is the practical threshold where PLC automation becomes cost-effective. Below that, the equipment cost premium for PLC control — about $15,000–$20,000 over manual systems — takes too long to pay back through labor savings and quality improvements.

ROI Payback by Production Scale

5 t/h

40 tons/day · 10,000 tons/year

10% defect reduction at $2,000/ton casting value = $2,000/year savings

8–10 year payback

Exceeds most buyers' ROI requirements

10 t/h

80 tons/day · 20,000 tons/year

10% defect reduction at $2,000/ton = $4,000/year savings

4–5 year payback

Acceptable for most operations

15 t/h

120 tons/day · 30,000 tons/year

Proportionally higher savings on scrap and rework

Under 3 year payback

Clear automation ROI

The crossover point where automation makes financial sense depends on your casting value and current defect rate, but 8–10 tons per hour is where most buyers see clear ROI.

Below 8 tons per hour?

Stick with manual control and invest in operator training and good maintenance practices — keep paddles sharp, calibrate moisture sensors regularly, maintain consistent water pressure. You'll get 80–85% of the quality benefit at 40–50% of the equipment cost.

Inquiry to Commissioning

Getting Started — From Inquiry to Commissioning

What we need from you to deliver an accurate quotation, and what your site needs before installation day.

Information We Need for an Accurate Quotation

Production & Integration Details

  • Target production capacity (tons per hour of prepared sand)
  • Existing equipment you're integrating with — molding line brand and model, conveyor types and dimensions, control system details
  • If replacing an older preparation system, tell us what's not working with your current setup — that helps us avoid specifying the same bottlenecks

Site & Electrical Specs

  • Available floor space — length × width, plus ceiling height if you have overhead cranes or vertical conveyors
  • Electrical supply specs — voltage, phase, available amperage

Target Sand Formulation

  • Clay type and content, moisture range, any specialty additives

Photos of Your Existing Foundry Layout

Photos help us spot potential installation issues before we finalize the quotation. Phone photos are sufficient — we're looking for spatial context, not engineering-grade documentation.

Installation area — to verify floor space and access for equipment delivery

Molding line feed hopper — to confirm conveyor interface requirements

Raw material storage — to plan input conveyor routing

Example foundry layout photo showing installation area for clay sand preparation line

Site Preparation Requirements

Foundation

Reinforced Concrete Slab

Clay sand preparation lines need a reinforced concrete foundation at least 150mm thick — less than molding lines or reclamation systems because preparation equipment generates less vibration.

Mixer weight: 1,500–3,000 kg depending on capacity. Dynamic loads during operation are modest — paddle mixers don't create the impact forces that molding presses do.

Upper floor installations: Check your building's load rating — a mid-scale system weighs 4–6 tons fully loaded with sand, which is within the capacity of most industrial building floors.

Electrical Service

Small-scale 15–22 kW
Mid-scale 30–45 kW
High-volume 60–85 kW

Add +20% overhead for startup surge current. Most buyers install a dedicated circuit breaker for the preparation line rather than tapping into existing foundry power — it simplifies troubleshooting and prevents voltage sags from affecting other equipment.

Compressed Air

Required if using pneumatic actuators for gates or valves.

Supply pressure 0.6–0.8 MPa
Flow rate 0.5–1 m³/min

Water Supply

For moisture addition to the sand mix.

Pressure 0.2–0.4 MPa
Flow rate 20–40 L/min

Shipping & Installation Timeline

Total elapsed time from order to first production batch: 65–100 days. Here's how that breaks down stage by stage.

1

Production

Manufacturing from deposit confirmation

45–60 days
2

Ocean Freight

Shipping time varies by destination port

15–30 days
3

Customs & Transport

Clearance and inland delivery to your site

3–5 days
4

On-Site Assembly

Module bolt-up, alignment, and connection

2–4 days
5

Commissioning & Training

Final checks and operator certification

1–2 days

Need Faster Delivery?

Air freight is available for small-scale systems — cuts shipping time from 15–30 days down to 5–7 days, but costs 4–5× more than ocean freight. Contact our logistics team to evaluate whether air freight makes sense for your timeline and budget.

Shipping Configuration by System Size

Small-Scale

Ships in one 20-foot container. Compact footprint, single-crate logistics.

Mid-Scale

Ships in one 40-foot container. Standard intermodal sizing for global logistics.

High-Volume

Ships in one 40-foot high-cube container. Extra height accommodates taller mixer assemblies.

Equipment frames break down into modules that clear container door dimensions, then bolt together on your factory floor. We provide assembly drawings and a parts list with each shipment, and our commissioning technician supervises the assembly process to ensure correct alignment and bolt torque.

Training & Documentation

On-Site Operator Training

Small-Scale

1–2 days during commissioning

Mid / High

2–3 days for mid-scale and high-volume systems

Training Covers
  • Startup procedures and normal operation
  • Parameter adjustment — moisture targets, clay content targets, mixer speed, conveyor speeds
  • Routine maintenance — lubrication, inspection, cleaning
  • Basic troubleshooting — sensor faults, conveyor jams, out-of-spec alarms

Training is hands-on — your operators run the equipment under our technician's supervision until they're comfortable with all normal and exception scenarios.

Documentation Package

Every clay sand preparation line ships with a complete documentation set for operations, maintenance, and long-term support.

Operations Manual

60–100 pages depending on system complexity

Electrical Schematics

Full wiring diagrams for all system components

PLC Program Backup

Delivered on USB drive for disaster recovery

Spare Parts Catalog

Part numbers and supplier contacts included

Maintenance Schedule

Preventive maintenance intervals and checklists

All documents ship in English. Other languages available on request for an additional $500–800 depending on language and document length.

After-Sales Support

Remote Diagnostics

VPN-based remote access — our engineers can log directly into your PLC and review process data when you report an issue, enabling fast root-cause identification without travel delays.

Spare Parts Ordering

Order via email or WhatsApp. We quote price and lead time within 24 hours. On-site service dispatched if remote support doesn't resolve the problem.

Response Times

  • China business hours (UTC+8): 4–8 hours remote support
  • Outside business hours: 12–24 hours for inquiries
  • Urgent production issues: WhatsApp +86 13335029477 — reaches our technical team directly

Ready to Specify Your Clay Sand Preparation Line?

Contact us at sales@tzfoundry.com with your capacity requirements and integration details. Include photos of your existing foundry layout if you're integrating the preparation line with current equipment — that helps us provide accurate specifications and avoid surprises during installation.

Preliminary specs & pricing within 24 hours Detailed proposal within 3–5 business days

Explore Related Clay Sand Equipment

Complete your clay sand processing system with complementary lines and machines from TZFoundry.
