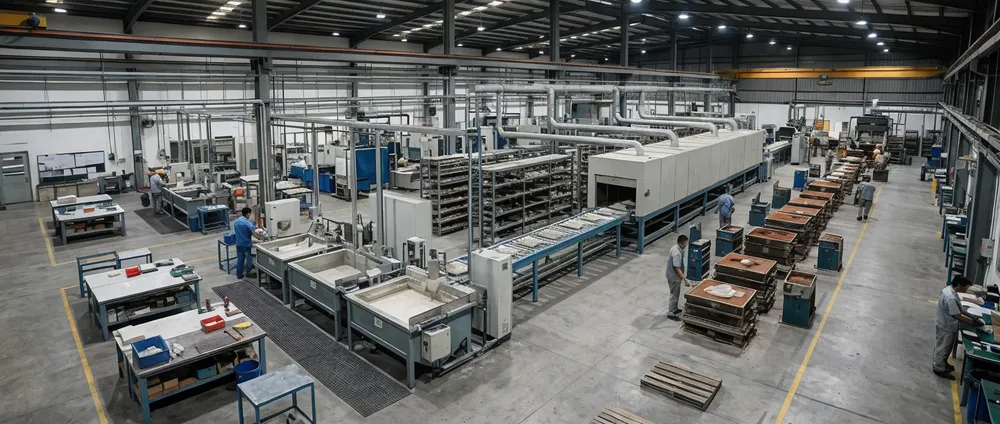

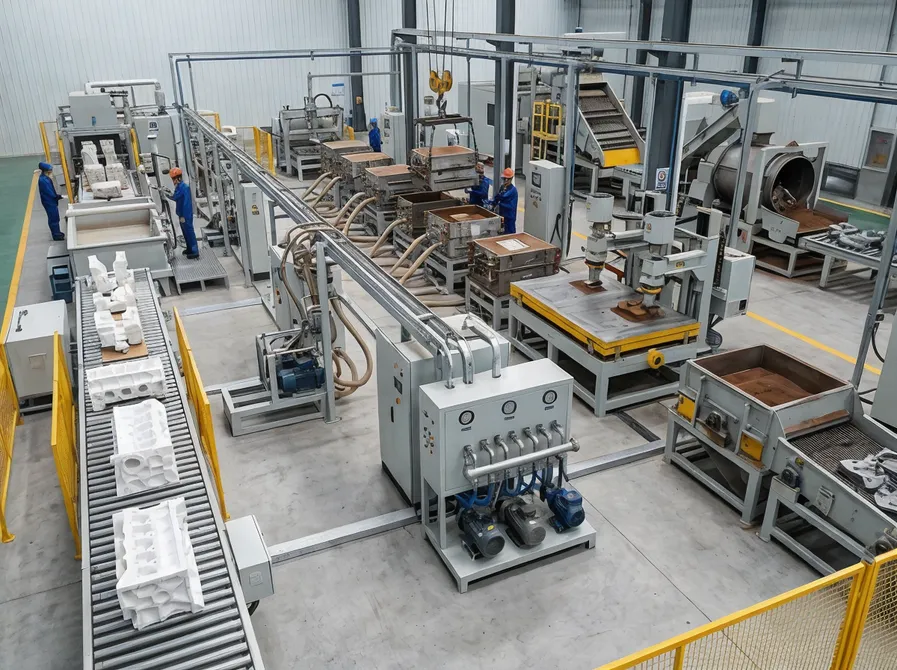

Lost foam casting machinery includes the individual equipment units that execute pattern handling, coating, molding, vacuum control, and shakeout operations. If you're upgrading capacity on an existing line, replacing aging equipment, or building a custom configuration instead of buying a complete turnkey system, you need machinery that integrates with what you already have and scales as production grows.
We manufacture pattern handling equipment, coating tanks and spray booths, molding machines with vibration control, vacuum systems with PLC regulation, and shakeout machinery with sand reclamation. Each machine ships as a standalone unit or as part of a modular configuration — you buy what you need now and add capacity later without replacing core equipment.
Storage, assembly, and coating prep systems for EPS and STMMA foam patterns.
Dip tanks, spray booths, and drying systems for refractory coating application.
Vibration tables and flask handling with precision compaction control.
PLC-regulated pressure control for mold stability during pour.
Casting separation and sand recovery for closed-loop reuse.
Siemens or Mitsubishi PLC integration with remote troubleshooting capability.
Our machinery integrates with Siemens or Mitsubishi PLCs, adapts to 380V/480V power standards, and ships with remote diagnostics capability so our technical team can troubleshoot without site visits.
Siemens or Mitsubishi PLC integration standard on all machinery. Adapts to your existing control architecture without rewiring.
380V and 480V configurations available. Machines ship configured for your facility's power standard — no third-party electrical conversion needed.
Built-in remote diagnostics on every unit. Our technical team can troubleshoot without site visits, reducing downtime on critical equipment.
Which machines you need depends on what you're doing. Here's how different foundry situations map to equipment priorities:
Foundries upgrading capacity typically add coating equipment or molding stations to eliminate bottlenecks.
Example: If your coating line runs 8 hours to prep patterns for a 6-hour molding shift, you need more coating throughput, not more molding capacity.
Foundries replacing aging equipment prioritize machines with the highest failure rates.
Typical failures: Vacuum pumps and coating drying systems fail first because they run continuously.
Foundries entering lost foam from green sand or permanent mold need the full machinery set.
Strategy: Start with manual equipment and automate incrementally as volume justifies the investment.

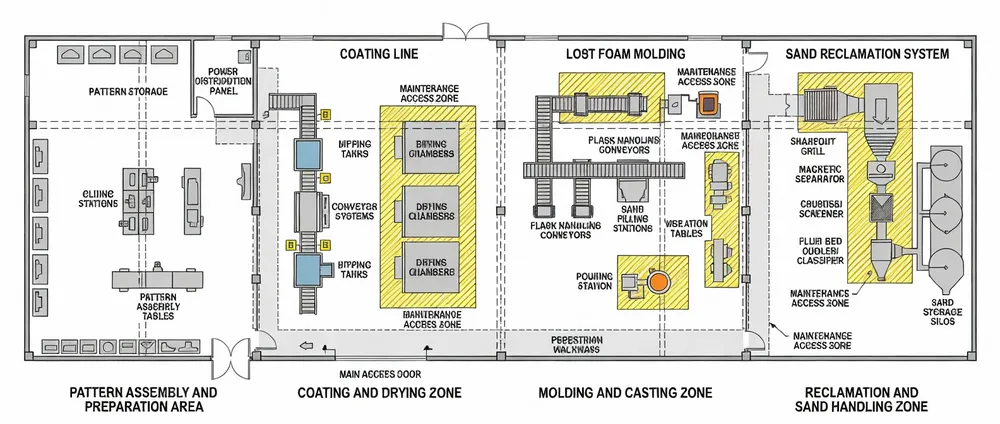

TZFoundry operates 8 production lines across 15,000 square meters in Qingdao, manufacturing foundry equipment since 2010. We build lost foam casting machinery, clay sand processing equipment, and resin sand production lines — all in-house.
Need a complete system?
View complete lost foam production line systems if you need an integrated turnkey solution instead of individual machines.

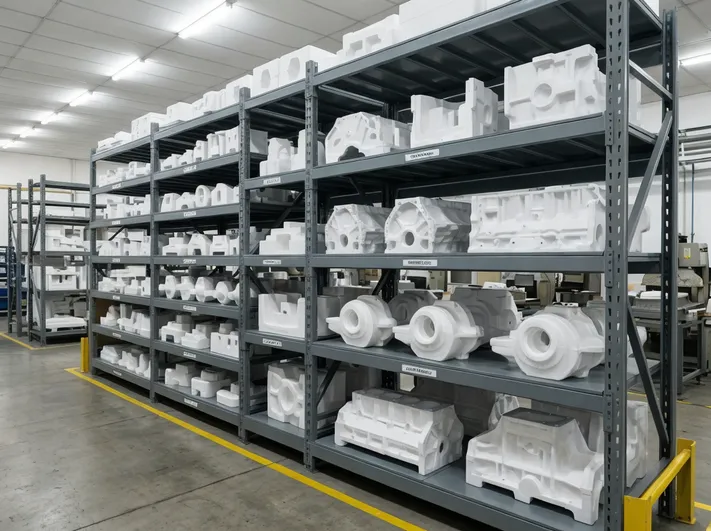

Pattern handling equipment manages EPS pattern flow from storage through gluing, assembly, and staging for coating. Storage racks hold 500–2,000 patterns depending on your casting size range and daily coating volume.
Storage racks hold 500–2,000 patterns depending on your casting size range and daily coating volume. Aluminum automotive parts (2–8 kg castings) need higher pattern counts because coating cycles are faster, while large iron castings (50–200 kg) use fewer patterns with longer coating and drying times.
Rack design uses adjustable shelving so you can reconfigure for different pattern geometries without custom fabrication.
Aluminum Automotive
2–8 kg castings — higher pattern counts, faster coating cycles
Large Iron Castings
50–200 kg — fewer patterns, longer coating and drying times
Adjustable pattern storage racks configured for mixed casting portfolios
Gluing stations bond multi-piece patterns using hot-melt or solvent adhesives. We size gluing capacity to match your coating line throughput: if you're coating 40 patterns per shift and 60% require gluing, you need gluing stations that handle 24 patterns in 6–7 hours.
Coating prep happens during the first half of the shift, then coated patterns dry while you prep the next batch.
Hot-Melt Systems
Adhesive heated to 160–180°C, applied via pneumatic guns. Cycle time 30–60 seconds per joint. Suitable for high-volume production.
Solvent-Based Systems
Room-temperature adhesives with 90–180 second cure times. Slower but better for complex geometries where hot-melt can distort thin sections.
Assembly fixtures position pattern sections for gluing and hold them during cure. Adjustable clamps accommodate different casting geometries — you're not building custom fixtures for every new part design.
Manual clamps — suitable for patterns under 5 kg
Pneumatic clamps — for heavier assemblies where operator fatigue becomes an issue
Alignment pins & registration surfaces — pattern halves mate consistently; misalignment at assembly shows up as parting line defects after casting
Automated pattern feeders stage patterns into coating equipment without manual handling. Conveyor systems with adjustable speed (1–5 meters/minute) move patterns from assembly to dip tanks or spray booths. Sensor-controlled spacing prevents pattern collisions during transfer.
Automation Breakpoint
For high-volume operations (200+ patterns per shift), automated feeding eliminates the labor bottleneck and reduces pattern damage from manual handling.
< 150
patterns/shift
Manual staging cheaper
> 150
patterns/shift
Automation pays back in 12–18 months
Pattern handling throughput determines coating line utilization. If your coating equipment can process 50 patterns per shift but pattern prep only delivers 35 patterns, you're paying for unused coating capacity. We map your casting portfolio — part geometries, gluing requirements, daily volumes — and size pattern handling equipment to match coating throughput.
Coating machinery applies refractory slurry to pattern surfaces — this layer controls metal-to-mold interface quality, surface finish, and gas permeability during pouring.

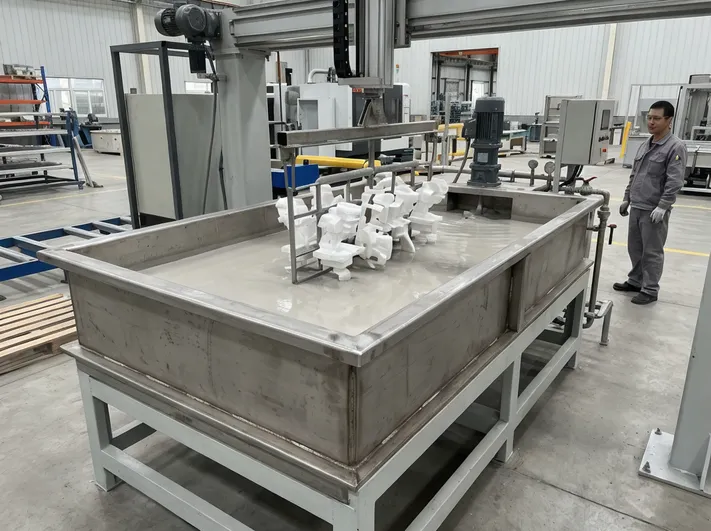

Dip tanks work for most casting geometries: patterns submerge in slurry, drain for 2–5 minutes, then transfer to drying. Tank capacity ranges from 200 liters for small parts and low volume up to 800 liters for large castings and high throughput. Slurry depth needs to exceed your largest pattern dimension by 100–150 mm so patterns fully submerge without touching the tank bottom.
Dip tank capacity: 200–800 liters. Slurry depth exceeds largest pattern dimension by 100–150 mm.
Run continuously at 20–40 RPM. Simple and reliable mechanical design with minimal moving parts.
Trade-off: Introduces air bubbles that can cause coating defects on finished patterns.
Pull slurry from the tank bottom and spray it back at the surface — better mixing uniformity with fewer air bubbles.
Trade-off: Pumps wear faster and need seal replacement every 12–18 months.

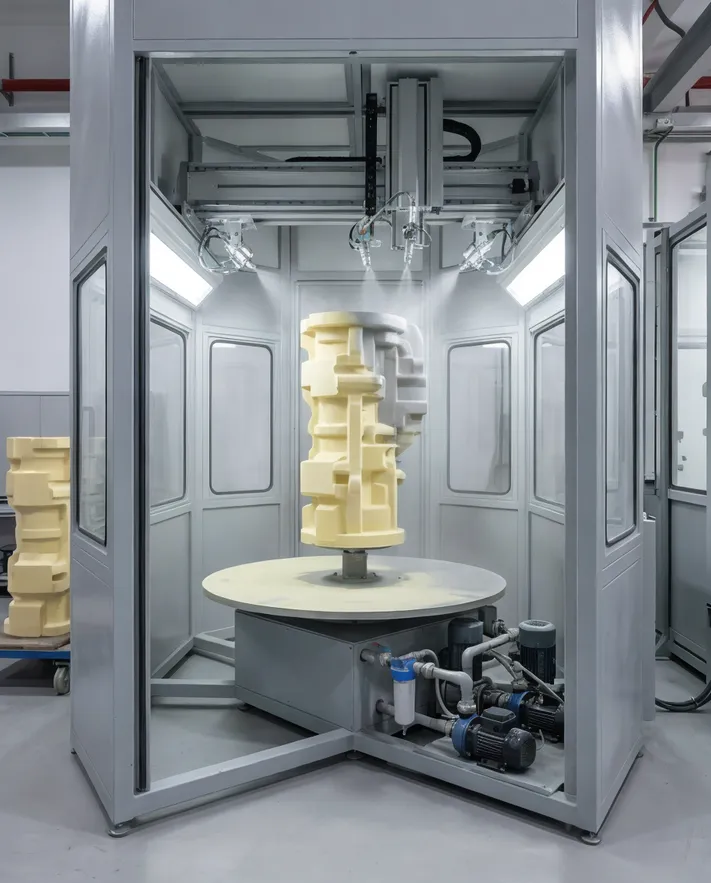

Spray booth with gantry-mounted guns and turntable rotation for uniform coverage on complex geometries.
Spray booths handle patterns too large or complex for dip tanks — engine blocks, manifolds, intricate cores where dip coating traps air in cavities.
Small parts: 1×1×1.5 m
Large industrial castings: 3×3×4 m
Pressure: 2–4 bar
Nozzle size: 1.5–3 mm (viscosity-dependent)
Automated spray guns mount on rotating arms or gantry systems, applying coating while patterns rotate on turntables. Booth ventilation extracts overspray and solvent vapors — typically 1,000–3,000 m³/hour airflow with filter stages to capture refractory particles before exhaust.
Viscosity control systems monitor slurry density and adjust refractory powder or water addition to maintain target coating thickness. Target range is 1.4–1.8 specific gravity depending on refractory type and desired coating thickness.
Density sensors (vibrating tube or ultrasonic) measure specific gravity every 15 minutes. When density drifts outside tolerance, the system adds water (if too thick) or refractory powder (if too thin) via metering pumps.
Consistent coating thickness, minimal operator interventionOperators check density with hydrometers every 2–4 hours. Lower upfront cost but less consistent results — and you're paying an operator to babysit slurry instead of doing productive work.

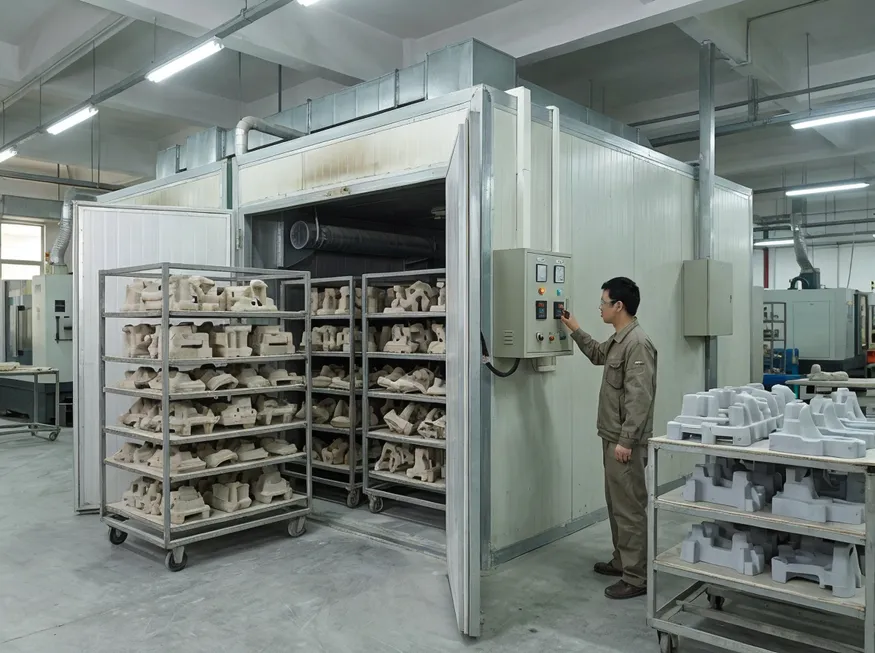

Cheaper upfront, higher long-term labor costDrying chambers cure coating before patterns enter molding. Gas-fired or electric heating maintains 40–60°C chamber temperature across 4–12 hour drying cycles, depending on coating thickness and humidity. Gas systems cost less to operate — natural gas is cheaper than electricity in most markets — but need ventilation for combustion gases. Electric systems are cleaner and easier to control but add 15–25% to operating cost.
Chamber capacity must match your daily coating volume. If you're coating 40 patterns per shift and drying takes 8 hours, you need chamber space for 40 patterns or you're queuing coated patterns overnight — and humidity exposure degrades coating quality.
Drying chambers must hold one full shift's output. Patterns coated during the shift dry overnight and are ready for molding at the start of the next production day.
Either double the drying capacity or accept that patterns coated in shift one dry during shift two. This works if you're running the same casting family both shifts — it doesn't work if you're switching between aluminum and iron because coating formulations differ.
Airflow and humidity control inside drying chambers affects cure uniformity. We include circulation fans and optional dehumidification for high-humidity climates where ambient moisture extends drying time by 30–50%.
Coating equipment selection depends on casting geometry and production volume. Simple shapes coat efficiently in dip tanks. Complex cores need spray booths. Mixed production runs both.
Best for simple shapes — pump housings, brackets, flanges. Complete dip tank system with agitation and drain racks.
Capital cost for complete system
Required for complex cores — engine blocks, manifolds. Includes booth, spray guns, turntable, and ventilation.
Capital cost for complete system
Dip tank handles 70–80% of castings (simple geometries). Spray booth covers the complex 20–30%. Most foundries run both.
Optimized capital allocation
Drying capacity scales with coating throughput. Budget $3,000–$5,000 per cubic meter of drying chamber volume. We size drying capacity using your production schedule to ensure chamber space matches daily coating output without overnight queuing.
Molding machinery fills flasks with sand around coated patterns and compacts to target density. Vibration tables provide the compaction force, while flask handling systems keep your line moving without bottlenecks.
Vibration tables operate at 50–100 Hz frequency with 0.5–2 mm amplitude, adjustable via PLC control. Table size matches your flask dimensions: 500×500 mm tables for small castings, 1000×1000 mm or larger for heavy parts. Table construction uses welded steel frames with spring or rubber isolation mounts to prevent vibration transmission to the building foundation.
PLC-controlled vibration systems store parameter recipes for different casting types. The operator selects the casting ID on the HMI, and the PLC loads the correct frequency, amplitude, and duration — eliminating manual tuning errors and ensuring consistent compaction across shifts. Manual systems use variable-frequency drives with analog dials, which works fine for continuous single-family casting runs but introduces variability when switching between products.

Vibration table with PLC recipe control and spring isolation mounts
Vibration parameters tune to sand type and flask size. Getting these right is the difference between consistent castings and a scrap pile.
Flask size directly affects vibration time — sand at the flask center takes longer to reach target density in larger molds.
| Flask Size | Sand Weight | Compaction Time | Handling Method |
|---|---|---|---|
| Small (500×500 mm) | 50–100 kg | 60–120 seconds | Manual — operators lift with handles or pallet jacks |
| Medium (up to 500 kg total) | 100–500 kg | 120–180 seconds | Overhead cranes — 2-ton capacity hoists with lifting fixtures |
| Large (1000×1000 mm+) | 500–1000 kg | 180–300 seconds | Conveyor systems — roller or chain-driven automated transfer |
Flask handling equipment positions empty flasks on vibration tables, transfers filled flasks to pouring stations, and returns empty flasks after shakeout. The right handling method depends on your flask weight and production volume.
For small flasks under 100 kg total weight. Operators lift flasks with handles or use pallet jacks. Lowest capital cost, suitable for low-volume or prototype operations.
For medium flasks (100–500 kg). Typically 2-ton capacity hoists with below-the-hook lifting fixtures. Balances flexibility with safe handling of heavier molds.
Roller conveyors or chain-driven systems move flasks through filling, compaction, and pouring without manual handling. Essential for high-volume automated lines.
Sand filling systems meter sand flow into flasks to prevent pattern damage. Gravity-fed hoppers with adjustable gates control fill rate — too fast and sand impact crushes thin pattern sections, too slow and you waste cycle time.
For automated lines, sand level sensors stop filling when the flask reaches target height, then trigger the compaction cycle automatically — removing operator timing from the equation.
Compaction uniformity directly affects dimensional consistency and defect rates. Under-compacted sand allows mold shift during pouring, causing dimensional errors. Over-compacted sand restricts gas escape, leading to porosity defects.
Calibrate vibration parameters during commissioning by measuring sand density at multiple flask locations. Target is ±2% density variation across the mold. Density measurement uses nuclear gauges or sand sampling with volumetric testing.
Once parameters are set, the PLC maintains consistency — but verify density weekly because sand properties drift as fines accumulate or moisture content changes.
Molding machinery capacity must match your pouring rate. If you're pouring 8 molds per hour and molding cycle time is 10 minutes (including flask positioning, sand filling, compaction, and transfer to pouring), you need at least two molding stations to avoid queuing.
Most foundries run 20–30% excess molding capacity as buffer against equipment downtime or process variations. Factor this into your line configuration from the start — adding a molding station after installation is significantly more disruptive than specifying the right count upfront.
Vacuum systems maintain negative pressure in the molding flask during pouring, pulling sand tight against the pattern as EPS vaporizes. This prevents mold collapse and maintains dimensional accuracy.
Iron Castings
0.02–0.04 MPa
Low vacuum requirement — iron's weight naturally compacts sand during pouring, reducing the need for high negative pressure.
Aluminum Castings
0.04–0.06 MPa
Higher vacuum required — aluminum's lower density creates less compaction force. Without sufficient vacuum, sand loosens as EPS vaporizes and the mold shifts.
Pump Capacity
50–200 m³/hr
Per molding station. Capacity depends on flask size and number of simultaneous pouring stations in your line configuration.
Rotary vane vacuum pumps are standard for lost foam applications. Oil-sealed design, available in single-stage or two-stage configurations depending on your target pressure requirements.
| Configuration | Pressure Range | Best For |
|---|---|---|
| Single-Stage | 0.04–0.05 MPa | Most iron castings |
| Two-Stage | 0.06–0.08 MPa | Aluminum & thin-wall castings where higher vacuum prevents mold shift |
Maintenance Intervals
PLC-controlled pressure regulators adjust vacuum level based on alloy type and casting size. Casting size directly affects vacuum requirement — here's how alloy and part weight interact:
Need less vacuum because EPS volume is small and vaporization happens quickly. Mold exposure time is short, reducing the window for sand displacement.
Need higher vacuum to stabilize the mold during extended pour times. Larger EPS volume means longer vaporization and more opportunity for mold shift without adequate negative pressure.

Pressure sensors at each molding station log vacuum readings every second. Sensor accuracy is ±0.002 MPa — tight enough to detect leaks or pump degradation before they cause casting defects.
If pressure drops below setpoint during pouring, the PLC triggers an alarm and can automatically hold the pour until vacuum recovers. This requires integration with pouring equipment but eliminates the need for operators to monitor vacuum manually during every pour.
90-Day Data Retention
Data logging stores 90 days of pressure readings, so when defect rates spike, you can correlate vacuum stability with casting quality and trace root causes quickly.
Multi-station vacuum distribution uses manifold systems with individual control valves for each molding station. Central vacuum pump feeds the manifold, and PLC-controlled valves regulate pressure to each station independently.
Manifold configuration costs less than dedicated pumps per station while providing centralized maintenance access.
If one pump fails, you can redistribute vacuum to critical stations and keep producing. Built-in redundancy without duplicating every pump.
PLC-controlled valves regulate pressure to each station independently. Pressure relief valves prevent over-vacuum conditions that can collapse molds or damage pumps.
Vacuum system integration with pouring equipment prevents defects from pressure loss during metal delivery. Interlock logic holds the pour if vacuum drops below setpoint, then resumes automatically when pressure recovers.
This requires communication between vacuum PLC and pouring control system — either hardwired I/O or industrial network protocols (Profibus, Ethernet/IP). We program and test these interlocks during commissioning so your operators don't need to monitor vacuum manually during every pour.
Communication Protocols Supported
Hardwired I/O
Direct signal connection between vacuum PLC and pouring control
Profibus
Industrial fieldbus for real-time process communication
Ethernet/IP
Industrial Ethernet protocol for networked control integration
Leak detection and maintenance are critical for vacuum system reliability. We include leak detection procedures in operator training: isolate each station, measure pressure decay rate, identify and repair leaks before they affect production.
Common Leak Sources
Preventive Maintenance Schedule
Separating castings from sand after solidification demands equipment matched to your alloy cooling profiles, production throughput, and sand quality targets. Each stage — cooling, shakeout, screening, magnetic separation, and dust collection — feeds directly into the next.

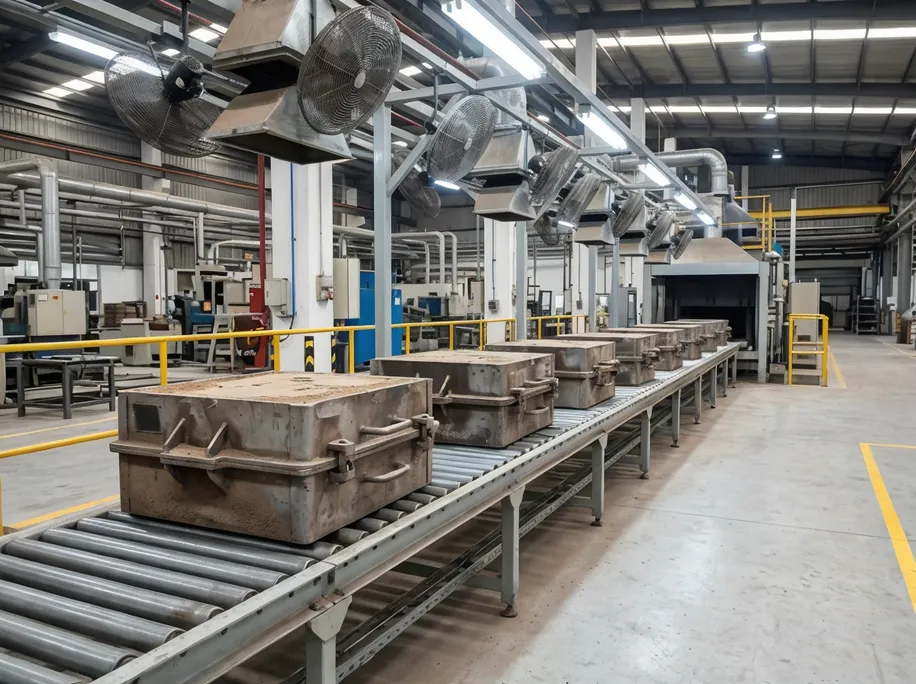

Cooling conveyors allow castings to reach handling temperature before shakeout. Cooling duration depends on alloy and casting mass — aluminum castings need 15–30 minutes, iron castings need 30–90 minutes.
Capacity Sizing Example
If you're pouring 8 molds per hour with a 30-minute cooling time, you need conveyor capacity for 4 molds (8 molds/hour ÷ 2 cycles/hour). Match conveyor length to your cooling time and production rate.
Belt Conveyors
Light flasks under 200 kg
Roller Conveyors
Heavy flasks where belt wear becomes excessive
Shakeout machinery vibrates or tumbles flasks to release castings and break up sand. Castings and sand fall through a grid onto collection conveyors while empty flasks return to the molding line. The choice between vibration and tumbler shakeout depends on your casting fragility and cycle time requirements.
Uses the same principle as molding compaction but with higher amplitude and lower frequency to fracture sand bonds. Better suited for fragile castings that cannot tolerate aggressive handling.
Rotates flasks 180° and dumps contents into a hopper. Faster cycle time but more aggressive action — can damage fragile castings. Best for robust geometries and high-throughput lines.
Vibrating screens remove casting debris, pattern residue, and oversized particles. Castings ride over the screen to a collection area while sand falls through to reclamation equipment.
10–20 mm mesh openings separate castings from sand in a single pass. Suitable for operations with uniform sand grain distribution.
Progressively finer mesh — 20 mm, 10 mm, 5 mm — classifies sand by particle size and removes fines that degrade permeability.
Screen inclination angle (5–15°) and vibration intensity (adjustable via eccentric weights) tune to your sand type and debris characteristics.
Suspended electromagnets or magnetic drums positioned over sand conveyors attract ferrous contamination — metal splashes, broken gates, iron oxide scale.
Critical for Iron Foundries
Even 1–2% iron contamination in sand causes defects in subsequent castings — metal penetration and rough surfaces. Magnetic separation is essential for any iron foundry line.
Aluminum foundries can skip magnetic separation unless they run both alloy types on the same line.
Baghouse filters capture fine particles during shakeout — EPS residue, coating dust, sand fines. Systems are sized for 5,000–15,000 m³/hour airflow depending on shakeout equipment size and sand handling rate.
Filter bags — polyester or PTFE, trapping particles down to 1–5 microns with automatic pulse-jet cleaning to prevent pressure buildup.
Collected dust composition — typically 30–50% refractory material and 50–70% sand fines.
Disposal options — landfill or cement kiln supplementary fuel (EPS residue has calorific value).
Sand reclamation machinery processes used sand for reuse. The choice between thermal and mechanical reclamation — or a combination of both — depends on your sand consumption rate, casting quality targets, and operating budget.
Passes sand through rotary kilns at 600–800°C to burn off EPS residue and coating binder. Restores sand permeability and reduces loss on ignition (LOI) to below 3%.
Cost offset: You avoid $40–80 per ton for new sand plus disposal cost for used sand.
Uses attrition mills to break up coating particles and scrub sand grains. High-speed rotating impellers (1,500–3,000 RPM) impact sand against mill walls, fracturing coating without crushing sand grains.
Typical strategy: Mechanical reclamation for daily turnover, thermal reclamation for periodic deep cleaning every 2–4 weeks.

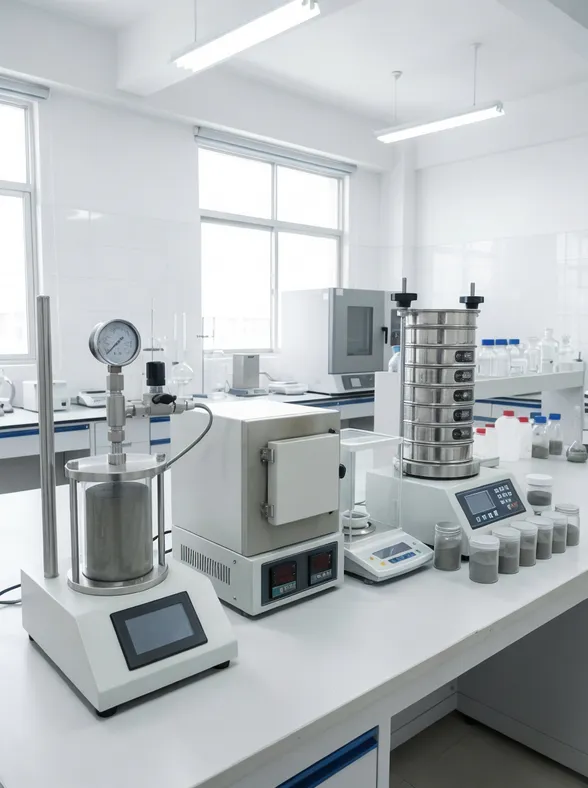

Sand testing equipment monitors reclaimed sand quality across three critical parameters. Consistent monitoring prevents casting defects before they reach the pour.
Measure airflow through sand samples. Target is 150–250 permeability units for lost foam applications. Lower permeability traps gases and causes porosity in finished castings.
Burn sand samples and measure weight loss. Target is below 3% for consistent casting quality. LOI above this threshold indicates incomplete reclamation and residual organic contamination.
Tracks sand degradation over reclamation cycles. As sand circulates through the system, grains fracture and fines accumulate, eventually requiring fresh sand addition to restore particle size distribution.
Reclamation capacity must match daily sand consumption. Under-sized reclamation creates a bottleneck where you're buying new sand continuously instead of reusing what you have.
100 ton/mo
Example foundry output
3–5 ton/day
Sand consumption (varies by casting size and sand-to-metal ratio)
6–8 hrs
Required processing window to avoid stockpiling
Cost impact of under-sizing: A $2,000/month sand cost turns into $8,000/month when reclamation can't keep up with consumption and you're forced to purchase new sand continuously.
Control systems integrate all machinery through PLC programming, providing centralized process monitoring, parameter adjustment, and data logging. We use Siemens or Mitsubishi PLCs depending on your preference and existing equipment base — if you're already running Siemens on other foundry equipment, we match that platform so your maintenance team works with familiar hardware and software.
HMI touchscreens at each equipment station display process parameters, alarm status, and production counts. Operators adjust coating viscosity setpoints, vacuum pressure targets, vibration parameters, and drying temperatures without accessing PLC code.
HMI screens show real-time sensor readings (pressure, temperature, flow rate) and trend graphs for the last 8–24 hours — this helps operators spot gradual parameter drift before it causes defects.
Every casting gets a unique ID linked to process data: coating batch number, drying time and temperature, vacuum pressure during pouring, sand LOI at molding time. When castings fail inspection, you pull the data logs for those specific molds and identify which parameter was out of spec.
Coating Batch
Batch number linked to each casting for material traceability
Drying Conditions
Time and temperature recorded per drying cycle
Vacuum Pressure
Pressure logged during pouring for mold stability verification
Sand LOI
Loss on ignition measured at molding time for sand quality
We've worked with foundries that cut scrap rates from 8–12% to 3–5% within six months just by using data logs to tighten process control — the equipment was capable of better quality, but without data visibility, operators couldn't identify which variables mattered most.

Remote diagnostics capability connects PLCs to our technical support team via Ethernet or 4G cellular. When equipment faults, we log into your PLC remotely, review alarm history, check sensor readings, and identify the root cause — usually within 2–4 hours.
Without remote access, you're describing symptoms over email, we're guessing at causes, and you're swapping components until something works.
60–70%
of technical issues resolved remotely without site visits
2–4 hrs
typical remote root-cause identification time
The remaining 30% need physical inspection or component replacement, but remote diagnostics tells us exactly which parts to bring, so we're not making multiple trips.
Alarm systems notify operators when parameters drift out of spec. Alarm priority levels distinguish between conditions that need attention within an hour and situations that require immediate production stoppage.
Visual alarms (flashing lights on HMI) and audible buzzers
Visual + audible alarms, plus optional SMS/email alerts
We program alarm setpoints during commissioning based on your process tolerances and quality requirements.
Multi-line monitoring allows one supervisor to oversee multiple production lines from a central control room. Network architecture connects individual equipment PLCs to a supervisory SCADA system that displays production status, equipment utilization, and alarm summaries for all lines.
This works for foundries running 2–4 lost foam lines or mixed operations (lost foam + green sand + resin sand) where centralized monitoring reduces labor cost and improves response time to equipment issues.
Integration requirements depend on your existing equipment and facility infrastructure. Voltage standards vary by region:
We configure motor starters, heaters, and control transformers to match your power supply.
PLC networking protocols are matched to whatever your existing equipment uses — no protocol converters or gateways required.
New machinery integrates directly into your existing control network without additional hardware.
Pressure sensors, temperature probes, and flow meters are specified to match your PLC input modules directly.
If you're adding a vacuum system to an existing line, the new pressure sensors match the signal type your PLC expects. During commissioning, we verify sensor calibration and scaling so displayed values match actual process conditions.
Control system documentation includes PLC ladder logic source code, HMI screen layouts, I/O wiring diagrams, and network architecture drawings. We provide this in editable format — not just PDFs — so your maintenance team can modify control logic, add new equipment, or troubleshoot faults without calling us for every change.
Editable source code for all control sequences and interlocks
Operator interface designs with full source files for modification
Complete input/output mapping for every sensor, actuator, and device
Communication topology drawings for PLC, HMI, and field device networks
Documentation also includes process parameter tables that explain the relationship between settings and casting quality. This is the knowledge transfer that lets your team optimize the line for new casting designs — understanding how adjustments to vacuum pressure, sand compaction frequency, or coating thickness affect final part quality without relying on external support for every product changeover.
Which machines to buy and in what sequence depends on your current situation and growth plan. Four common scenarios guide the decision.
You're running a lost foam line that's hitting throughput limits. Identify the bottleneck first — if coating drying takes 12 hours but you're only running 8-hour shifts, you need more drying capacity, not more coating tanks. If molding stations are idle 30% of the time waiting for coated patterns, you need faster pattern handling or additional coating equipment.
How We Approach It
We map your current process cycle times — pattern prep, coating, drying, molding, pouring, shakeout — and identify which stage limits throughput. Then we size additional machinery to eliminate that bottleneck.
Typical investment: $30,000–$80,000 for capacity upgrades (adding one coating line, expanding drying chambers, or adding molding stations).
Vacuum pumps, coating drying systems, and vibration motors fail most frequently because they run continuously under harsh conditions — heat, dust, chemical exposure.
Expected Service Life by Component
Upgrade Recommendation
When planning replacements, consider upgrading to PLC-controlled versions even if your current equipment is manual — the control precision and data logging capability usually justify the 20–30% cost premium. Replacement machinery integrates with existing equipment through mechanical interfaces and electrical connections, so you're not rebuilding the entire line.
You need lost foam capability but your casting mix, facility layout, or budget doesn't fit a standard turnkey line. Start with core equipment: coating system (dip tank or spray booth depending on casting geometry), drying chambers sized for daily volume, molding machinery (vibration tables and flask handling), and vacuum system. This gets you producing castings.
Then add automation incrementally: pattern handling conveyors, automated coating viscosity control, PLC integration, remote diagnostics.
Investment Pathway
Manual Starter Configuration
$120,000–180,000 — core equipment producing castings from day one
Incremental Automation (2–3 Years)
Total investment reaches $250,000–350,000 — same capability as a turnkey automated line but spread over time as production volume and cash flow grow
You're currently running green sand, permanent mold, or investment casting and want to add lost foam capability for specific product lines. Evaluate which castings suit lost foam — complex geometries with tight tolerances, low-to-medium production volumes (50–2,000 units/year per part), aluminum or iron alloys.
Don't convert your entire operation; run lost foam alongside existing methods and shift products gradually as you build process expertise. Initial machinery investment focuses on proving the process: small coating system, batch molding equipment, manual material handling.
Proof-of-Concept Line
$80K–150K
Initial investment
3–8 T/mo
Production capacity
Once you've validated quality and economics, scale up with additional coating capacity, automated molding, and higher-throughput shakeout equipment.
These factors affect machinery selection regardless of your entry scenario. Verify each before committing to equipment specifications.
Verify your facility has available electrical capacity for new equipment.
80–150 kW
Complete line draw depending on configuration
Machinery footprint plus clearance for maintenance access and material flow:
If you're integrating with existing equipment, new machinery must communicate with your current PLC platform — otherwise you're building isolated systems that can't share data.
Each automation step adds 15–25% to equipment cost but reduces labor by 20–40% and improves process consistency. At $15–20/hour labor rates and 200+ tons/year production, automation pays back in 18–24 months.
Manual equipment for pattern handling and flask transfer. Lowest capital outlay, highest labor requirement.
Automated viscosity control with manual pattern loading. Balances investment against labor savings and consistency gains.
Conveyor-fed coating, automated molding, integrated control. Maximum throughput and process repeatability.
| Machinery Category | Investment Range | Includes |
|---|---|---|
| Pattern Handling | $15,000–40,000 | Storage racks, gluing stations, assembly fixtures |
| Coating Systems | $25,000–80,000 | Dip tanks or spray booths, viscosity control, drying chambers |
| Molding Machinery | $30,000–70,000 | Vibration tables, flask handling, sand filling |
| Vacuum Systems | $20,000–50,000 | Pumps, regulators, distribution manifolds, sensors |
| Shakeout & Reclamation | $40,000–100,000 | Cooling conveyors, shakeout equipment, sand separation, dust collection, reclamation machinery |
| Control System Integration | $15,000–35,000 | Depends on automation level and remote diagnostics capability |
Need a complete turnkey configuration?
View complete lost foam production line systems if you're building a new foundry or replacing an entire line rather than upgrading individual machines.
Typical capacity, power, footprint, control, and lead-time ranges for standard lost foam casting machinery configurations. Exact specifications vary by customization level and production requirements.
| Equipment Type | Capacity / Throughput | Power Requirements | Footprint Dimensions | Control Options | Typical Lead Time |
|---|---|---|---|---|---|
| Pattern Storage Racks | 500–2,000 patterns | None (passive) | 3×2×2.5m to 6×3×3m | N/A | 4–6 weeks |
| Gluing Stations | 20–60 patterns/shift | 2–5 kW (hot-melt systems) | 1.5×1×1.2m per station | Manual or PLC | 6–8 weeks |
| Dip Coating Tanks | 200–800L capacity | 3–8 kW (agitation) | 2×1.5×1.5m to 4×2×2m | Manual or automated viscosity control | 8–10 weeks |
| Spray Coating Booths | 1–3 m³ work volume | 8–15 kW (spray + ventilation) | 2×2×2.5m to 4×4×5m | PLC with automated spray guns | 10–12 weeks |
| Drying Chambers | 2–8 m³ capacity | 15–40 kW (electric) or gas-fired | 2×2×2.5m to 4×3×3m | Temperature control, timers | 8–10 weeks |
| Vibration Tables | 500×500mm to 1,200×1,200mm | 2–8 kW per table | 1×1×1m to 2×2×1.2m | Manual VFD or PLC recipes | 8–10 weeks |
| Flask Handling (Cranes) | 1–5 ton capacity | 3–10 kW | Overhead installation | Manual or semi-automated | 6–8 weeks |
| Vacuum Pumps | 50–200 m³/hr per station | 5–15 kW per pump | 1×0.8×1.2m per pump | PLC pressure regulation | 8–10 weeks |
| Cooling Conveyors | 4–12 molds capacity | 2–5 kW | 6–15m length × 1–1.5m width | Variable speed control | 8–10 weeks |
| Shakeout Equipment | 6–15 molds/hour | 5–12 kW | 3×2×2m to 5×3×2.5m | Manual or automated cycle | 10–12 weeks |
| Sand Reclamation (Thermal) | 500–2,000 kg/hr | Gas-fired (200–500 kW thermal) | 8–15m length × 2–3m width | Temperature control, feed rate | 12–14 weeks |
| Sand Reclamation (Mechanical) | 1,000–3,000 kg/hr | 15–40 kW | 3×2×2.5m to 5×3×3m | Variable speed, PLC | 10–12 weeks |
| Dust Collection Systems | 5,000–15,000 m³/hr | 10–25 kW | 2×2×3m to 3×3×4m | Automatic pulse cleaning | 8–10 weeks |
Specifications shown are typical ranges for standard configurations. Exact specs vary by customization. Contact us for detailed machinery data sheets tailored to your foundry's throughput and layout requirements.
From passive storage racks to 500 kW thermal reclamation — plan your electrical and gas infrastructure around these baselines.
Compact single-station units from 1×0.8m up to 15m-length conveyors and reclamation lines — use these dimensions for facility layout.
4–14 weeks depending on equipment complexity. Thermal sand reclamation carries the longest lead; passive storage ships fastest.
Getting machinery into your facility is only half the job — matching power supply, floor space, and control architecture to your existing operation determines how fast you reach production quality.
Power supply requirements vary by machinery configuration. Individual machines draw 2–40 kW depending on type and size — pattern handling equipment needs minimal power (2–5 kW for gluing stations), while coating drying chambers and sand reclamation equipment draw 15–40 kW.
Total electrical capacity for a complete machinery set. Verify your facility has available capacity before ordering.
If you're running near your transformer limit, you'll need electrical service upgrades that add 8–12 weeks to your installation timeline. Factor this into procurement planning.
Voltage and frequency standards must match your regional power supply. Motor starters, heating elements, and control transformers ship pre-wired for your voltage specification.
Europe · Asia · Middle East
North America
Unstable Power Supply Regions
We recommend adding voltage regulators or UPS systems for control equipment — PLC memory corruption from power fluctuations causes more downtime than mechanical failures in our experience.
Facility space planning accounts for equipment footprint plus maintenance clearance. Allow 1–1.5 meters clearance on all sides for operator access and maintenance.
Includes dip tanks, drain racks, and drying chambers. Allow 1–1.5 m clearance on all sides for operator access and maintenance.
Covers vibration tables, sand hoppers, and flask staging areas for molding and compaction operations.
Conveyor systems and dust collection ductwork require more floor space than compact machinery.
Total facility requirement depending on production capacity and layout efficiency.
PLC Integration & Communication Protocols
Control system compatibility matters when integrating new machinery with existing equipment. If you're running Siemens PLCs on your current line, we configure new machinery with Siemens controllers so everything communicates on the same network.
Same-brand controllers communicate on the same network — centralized monitoring and data sharing across your entire line.
Requires protocol gateways or separate control systems — this works but eliminates the benefit of centralized monitoring and data sharing.
We match your existing protocol during engineering design so network integration happens during commissioning without additional hardware.
From mechanical assembly through operator training
Commissioning timeline includes mechanical assembly, electrical hookup, parameter calibration, and operator training.
Pattern handling equipment assembles quickly (2–3 days), while coating systems with drying chambers and reclamation equipment take longer (5–7 days).
Power connections, control wiring, and sensor installation across all machinery stations.
Test batches with your sand and coating materials — tuning vibration frequencies, drying temperatures, vacuum pressures, and reclamation settings to achieve target quality.
Covers equipment operation, parameter adjustment, routine maintenance, and troubleshooting procedures for your team.
2–4 Weeks
From equipment arrival to production-ready status
This assumes your facility preparation is complete — power supply installed, floor space cleared, overhead cranes rigged if needed.
Common Delay Factor
Delays typically come from incomplete facility prep. If we arrive and your electrical service isn't ready or floor anchors aren't installed, we're waiting on your contractors before we can proceed.
Training requirements depend on automation level. Two distinct tracks cover the range of equipment configurations:
Manual Equipment Operators
Operators need to understand process fundamentals — coating viscosity effects, vibration parameter selection, vacuum pressure requirements. Training focuses on parameter adjustment based on casting results.
Automated Equipment Operators
Operators need to interpret HMI displays, respond to alarms, and perform basic PLC troubleshooting. Less process-level adjustment, more system monitoring and diagnostics.
Operation Manuals
Complete operating procedures for every machine in your line
Maintenance Schedules
Preventive maintenance intervals and replacement part lists
Troubleshooting Guides
In English, with other languages available on request
Follow-Up Support
Phone/email technical assistance plus optional on-site visits during the first 6–12 months of operation
Send us your current equipment list, casting portfolio, and facility constraints so we can recommend the right configuration.
Technical answers to the questions foundry engineers and procurement teams ask most when specifying, sizing, and integrating lost foam casting machinery.
Power requirements range from 2 kW for small pattern handling equipment to 40 kW for large drying chambers and sand reclamation machinery. A typical machinery configuration for 50-ton/month production draws 80–120 kW total. Voltage standards are 380V three-phase 50 Hz (Europe, Asia, Middle East) or 480V three-phase 60 Hz (North America) — we configure equipment to match your regional power supply.
Verify your facility has available electrical capacity before ordering. If you're near your transformer limit, plan for electrical service upgrades that add 8–12 weeks to installation timeline.
Yes, if control system compatibility is addressed during engineering design. We configure new machinery to match your existing PLC platform (Siemens, Mitsubishi, Allen-Bradley) so equipment communicates on the same network. Mixed PLC brands require protocol gateways or separate control systems — this works but eliminates centralized monitoring benefits.
We review your current equipment specifications during quoting and identify integration requirements. Most common integration scenario: adding coating capacity or molding stations to existing lines. This requires matching flask sizes, coordinating control signals (start/stop, alarm status), and verifying that upstream/downstream equipment can handle increased throughput.
PLC Platform Note: We configure new machinery to match Siemens, Mitsubishi, or Allen-Bradley platforms. Mixed PLC brands require protocol gateways or separate control systems — functional, but centralized monitoring benefits are lost.
Production lead time is 12-16 weeks for most machinery types. The total timeline from order to production-ready runs 16-24 weeks, depending on equipment complexity, shipping distance, and installation scope.
Pattern Handling Equipment
4-8 Weeks
Simpler fabrication requirements allow shorter production cycles.
Coating Systems
8-12 Weeks
Tanks, spray booths, and drying chambers require more manufacturing steps.
Molding & Vacuum Equipment
8-10 Weeks
Mid-range complexity with standard engineering configurations.
Shakeout & Reclamation
10-14 Weeks
Largest and most complex systems in the production line.
Shipping (Ocean Freight)
2-4 Weeks
Covers transit to most export markets worldwide.
Installation & Commissioning
2-4 Weeks
On-site setup, calibration, and production validation.
Expedited production is available for a 15-20% premium, reducing lead time to 8-10 weeks for critical equipment. Custom configurations that require engineering design add 2-4 weeks for design and approval cycles before production starts.
Vacuum system sizing depends on three factors: alloy type, casting size, and number of simultaneous pouring stations. Getting the sizing right ensures mold stability during pouring and consistent casting quality.
Vacuum Pressure by Alloy Type
Aluminum Castings
0.04-0.06 MPa
Aluminum's lower density creates less sand compaction force. Without sufficient vacuum, molds shift during pouring, causing dimensional defects and surface irregularities.
Iron Castings
0.02-0.04 MPa
Iron's higher weight naturally compacts sand around the pattern, so lower vacuum pressure is sufficient to maintain mold integrity during the pour cycle.
Pump Capacity by Casting Size
| Casting Size | Weight Range | Pump Capacity per Station |
|---|---|---|
| Small Castings | <5 kg | 50-80 m³/hour |
| Large Castings | >50 kg | 120-200 m³/hour |
Larger castings vaporize more EPS and require vacuum maintenance over longer pour times, driving higher pump capacity requirements.
Multi-Station Configuration
Multiple pouring stations require either dedicated pumps per station or a central pump with manifold distribution. For central pump sizing: sum the capacity for all stations, then add 20-30% buffer for leaks and system losses.
Sizing Example
Setup: Three molding stations running aluminum castings, 10-20 kg average weight
Per-station capacity: 100 m³/hour each
Combined capacity: 3 × 100 = 300 m³/hour
With 30% buffer: 300 × 1.30 = 390 m³/hour pump capacity
We size vacuum systems during quoting based on your casting portfolio and production layout.
Maintenance frequency and tasks vary by equipment type. We provide maintenance schedules with recommended service intervals and spare parts lists. Most foundries handle routine maintenance (oil changes, filter cleaning, lubrication) with in-house staff and call us for major repairs (pump rebuilds, motor replacement, PLC troubleshooting).
Highest-maintenance component — pumps run continuously under harsh conditions.
Minimal maintenance required.
Manual equipment costs 30–40% less than automated systems but requires more labor and produces less consistent results. The economic breakpoint depends on your labor cost and production volume.
Best when you're proving the process or running low volume. Automation cost doesn't justify the savings at this scale.
Automated coating viscosity control and vacuum pressure regulation (the parameters that most affect quality) with manual material handling — lower capital cost than full automation.
At $15–20/hour labor rates and 200+ tons/year production, automation pays back in 18–24 months through labor savings and reduced scrap rates.
Automation Consistency Advantage
PLC-controlled systems hold tighter parameter tolerances than manual operation, reducing defect rates by 30–50% in our experience.
If you're running high-value castings where scrap cost is significant, automation justifies itself at lower production volumes. Start with manual equipment if you're proving the process or running low volume, then add automation incrementally as production grows.
We've manufactured foundry equipment since 2010, running 8 production lines across 15,000 square meters in Qingdao. Lost foam casting machinery, clay sand processing equipment, and resin sand production lines — all built in-house with ISO 9001:2015, CE, and SGS certification. You're buying directly from the factory, so there's no distributor markup and we'll configure single-unit orders to your specifications.
Our machinery uses modular design philosophy — equipment scales without replacement. When your production grows from 50 tons/month to 150 tons/month, you add coating capacity or molding stations without rebuilding the line.
We've worked with foundries that started with 3-machine configurations and expanded to 12-machine lines over 5 years — the original equipment is still running because we designed for growth from the start.
Standard vacuum systems cover 80% of applications, but if you're running unusual alloy combinations or casting geometries outside typical ranges, we'll engineer custom pump configurations and pressure control logic.
Coating formulation support helps you match refractory slurry properties to your casting requirements — we've tested 40+ coating recipes across aluminum, iron, and steel alloys and can recommend formulations that work with your pattern materials and drying equipment.
40+ tested formulations across aluminum, iron, and steel alloys — matched to your pattern materials and drying setup.
Direct factory pricing eliminates distributor margins. Machinery that costs $180,000–$220,000 through distributors ships from us at $140,000–$170,000 for equivalent specifications. You're paying for manufacturing cost plus our margin, not three layers of markup.
This matters more on large orders — a complete machinery set saves $40,000–$80,000 compared to distributor pricing, which funds your facility preparation or buys additional automation.
Typical Savings Per Complete Set
vs. distributor pricing
Distributor
$180K–$220K
Factory Direct
$140K–$170K
Export experience covers 15+ countries across North America, Europe, Middle East, and Southeast Asia. We handle voltage adaptation (380V/480V, 50Hz/60Hz), control system localization (HMI screens in English, Spanish, Arabic, or other languages), and customs documentation (commercial invoices, packing lists, certificates of origin).
Voltage Adaptation
380V/480V, 50Hz/60Hz
HMI Localization
English, Spanish, Arabic & more
Customs Documentation
Invoices, packing lists, COO
Container Shipping
20GP or 40HQ with protective packaging
Equipment ships in standard containers (20GP or 40HQ depending on machinery size) with protective packaging and installation hardware included. We've shipped to facilities with challenging logistics — remote locations, restricted site access, limited crane capacity — and can advise on rigging and installation planning.
Service model includes 24-hour technical support via phone, email, and remote diagnostics. When equipment faults, we log into your PLC remotely (if you've enabled network access), review alarm history and sensor data, and identify root causes within 2–4 hours.
We've resolved 60–70% of technical issues remotely without site visits. For issues requiring physical inspection or component replacement, we dispatch technicians or ship spare parts via express courier (3–5 days to most markets).
Warranty Coverage
18 months from commissioning or 24 months from shipment, whichever comes first — this protects you during the learning curve when operators are still developing process expertise.
Spare parts warehouse stocks wear components for all machinery types:
3–5 Days
Stocked parts lead time
6–12 Weeks
Custom-manufactured parts
We recommend stocking critical spares on-site — vacuum pump rebuild kits, spare sensors, motor contactors — so you're not waiting on international shipping when equipment fails. We'll provide recommended spare parts lists during commissioning based on your production schedule and maintenance capabilities.
Send us your current equipment list, casting portfolio, and facility constraints so we can recommend the right machinery configuration.
What machinery you're already running (if upgrading existing lines):
Details about your casting operations and requirements:
Your site conditions and infrastructure details:
We'll respond within 24 hours with machinery recommendations, technical specifications, factory pricing, and lead time estimates. For complex configurations requiring custom engineering, we'll schedule a technical review call to discuss integration requirements and process optimization opportunities.
For standalone machinery units. Expedited production available for critical orders.
Contact Directly
Include your equipment list, casting portfolio, and facility details for the fastest response.
